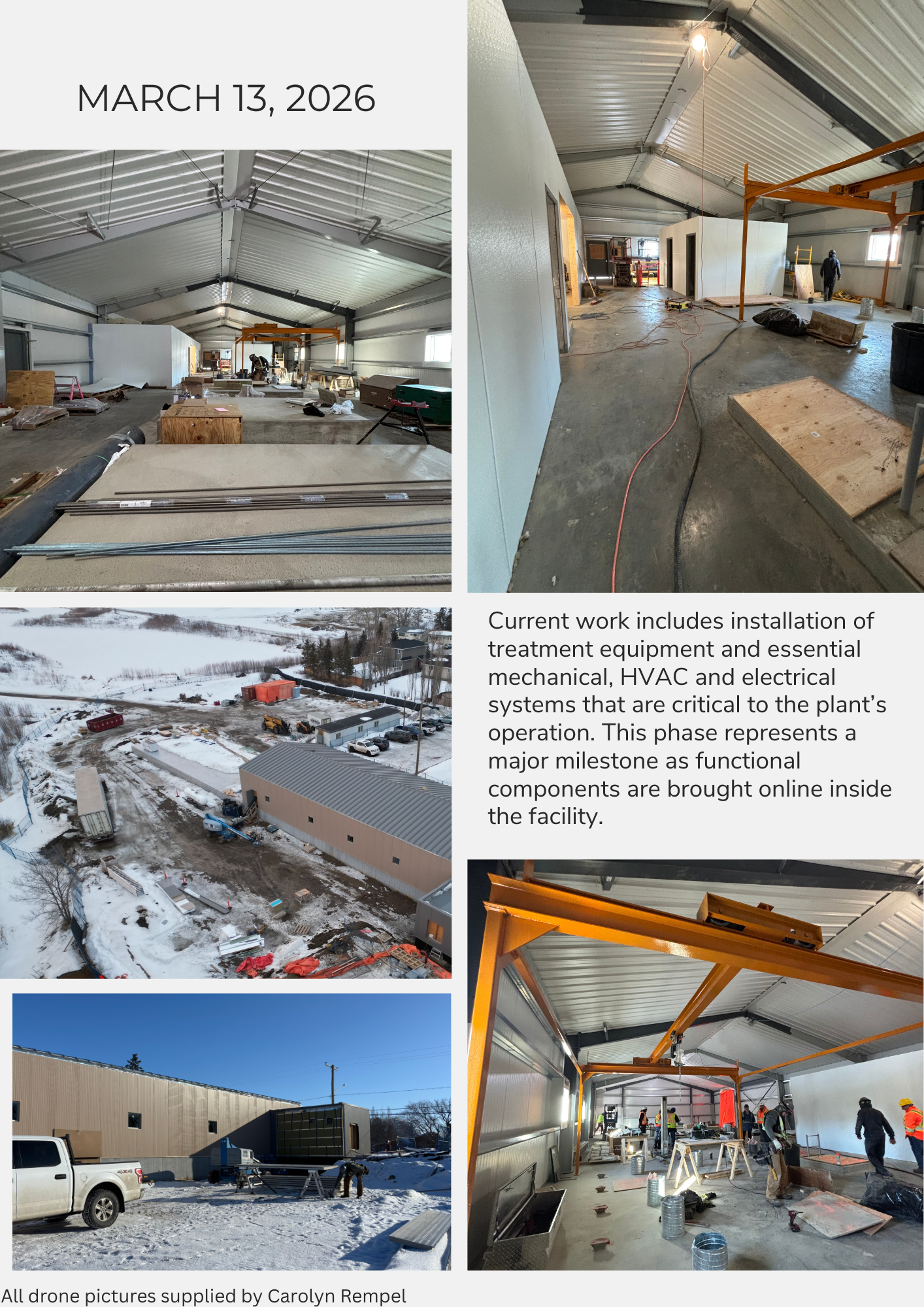

Water Supply and Treatment Plant Upgrades


Updates posted below

We are very pleased to announce that the Town of Rosthern has been approved for funding from the Investing in Canada Infrastructure Program - Green Infrastructure to complete the Water Supply and Treatment Plant Upgrades!

This funding has given us the opportunity to complete major capital upgrades including:

  • Construct five new water wells
  • New Water Treatment Plant with larger water reservoir
  • Install new raw water supply lines
  • Integrate a new communications system
  • Upgrade existing well control buildings
  • Demolition of the old Water Treatment Plant and reservoir


The full project will cost $19.6 million with the funding contributions broken down as follows:

  • Federal - $7,843,152
  • Provincial - $6,535,306
  • Municipal - $5,229,422


This project will without a doubt revitalize our aging water infrastructure and secure its longevity so that it can accommodate current demand, future growth, and new servicing requirements which are presenting daily!

Water Supply and Treament Plant Upgrades

Keep watch for updates as the project progresses

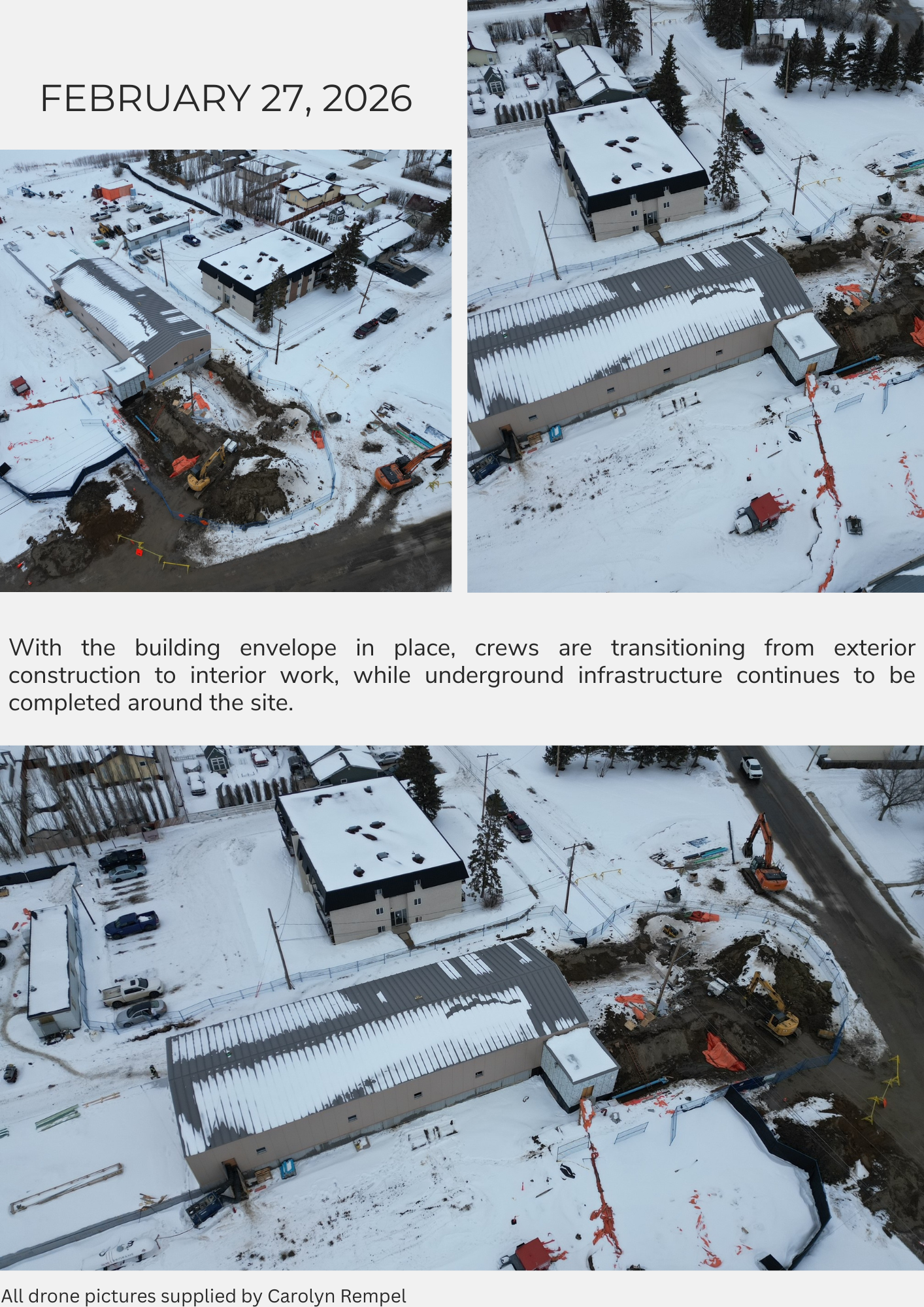

January 19, 2026

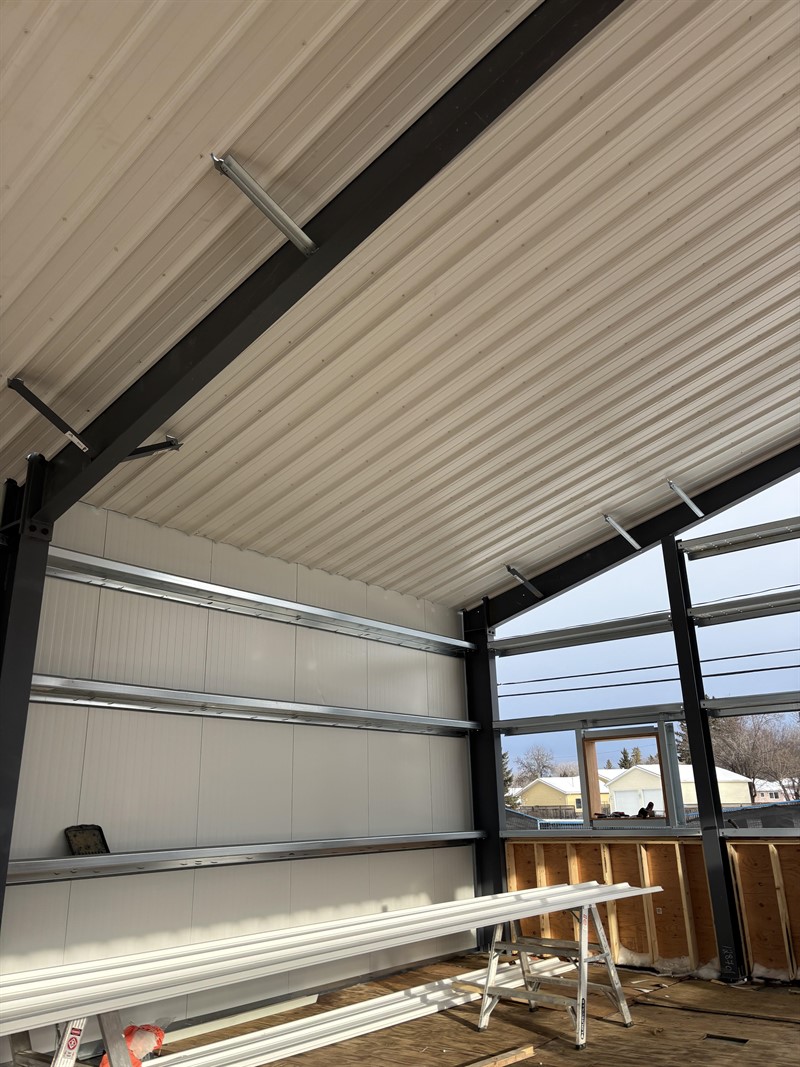

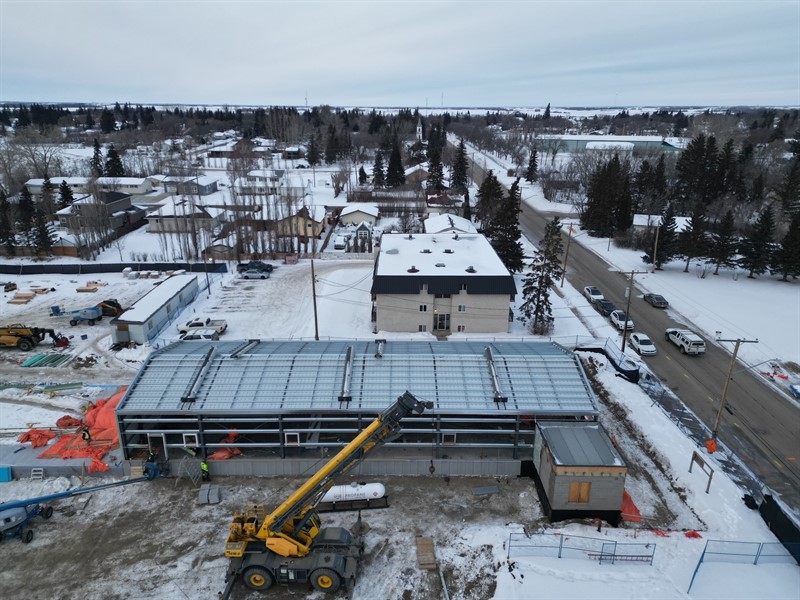

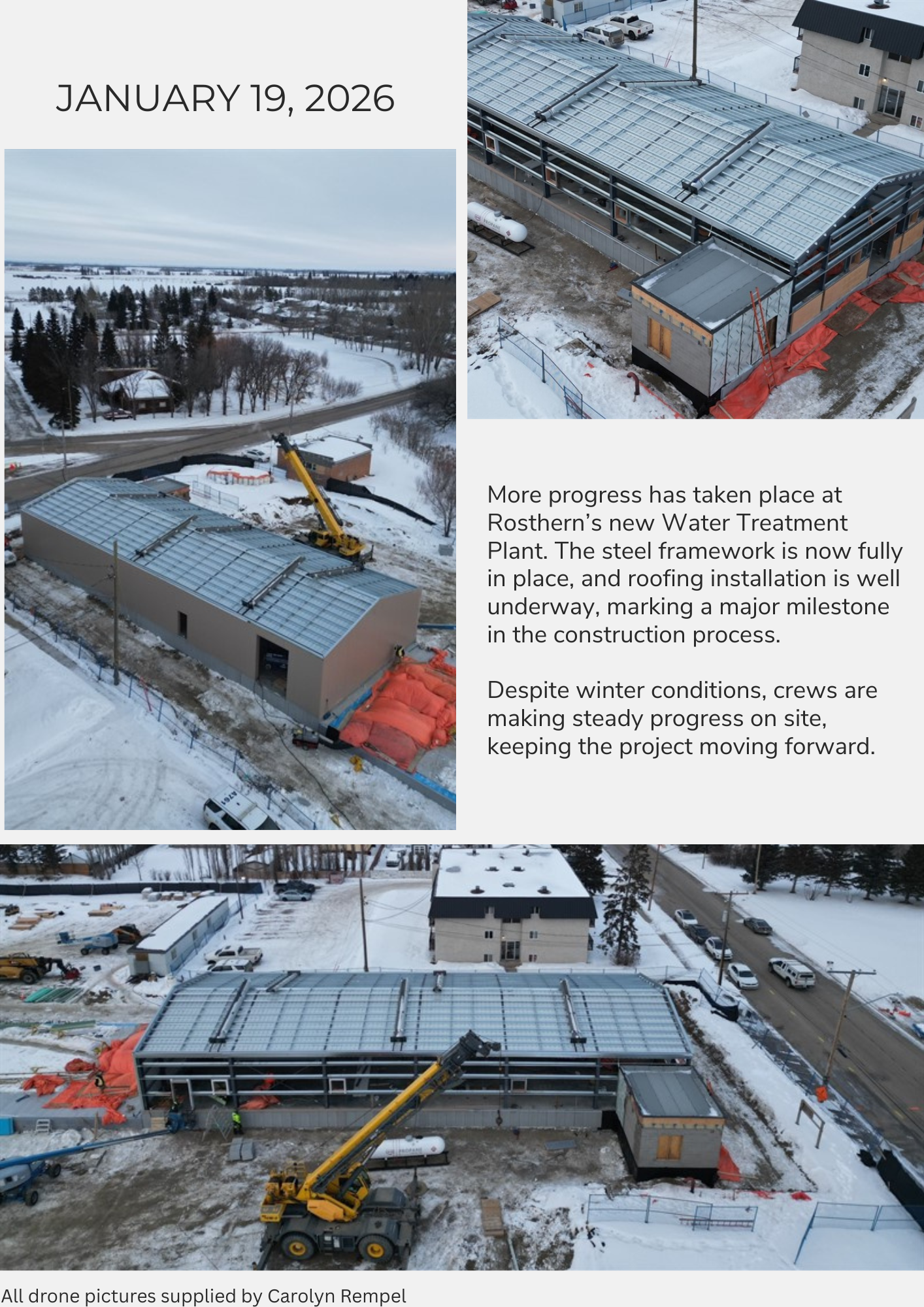

The Roof is Going On! Construction Update

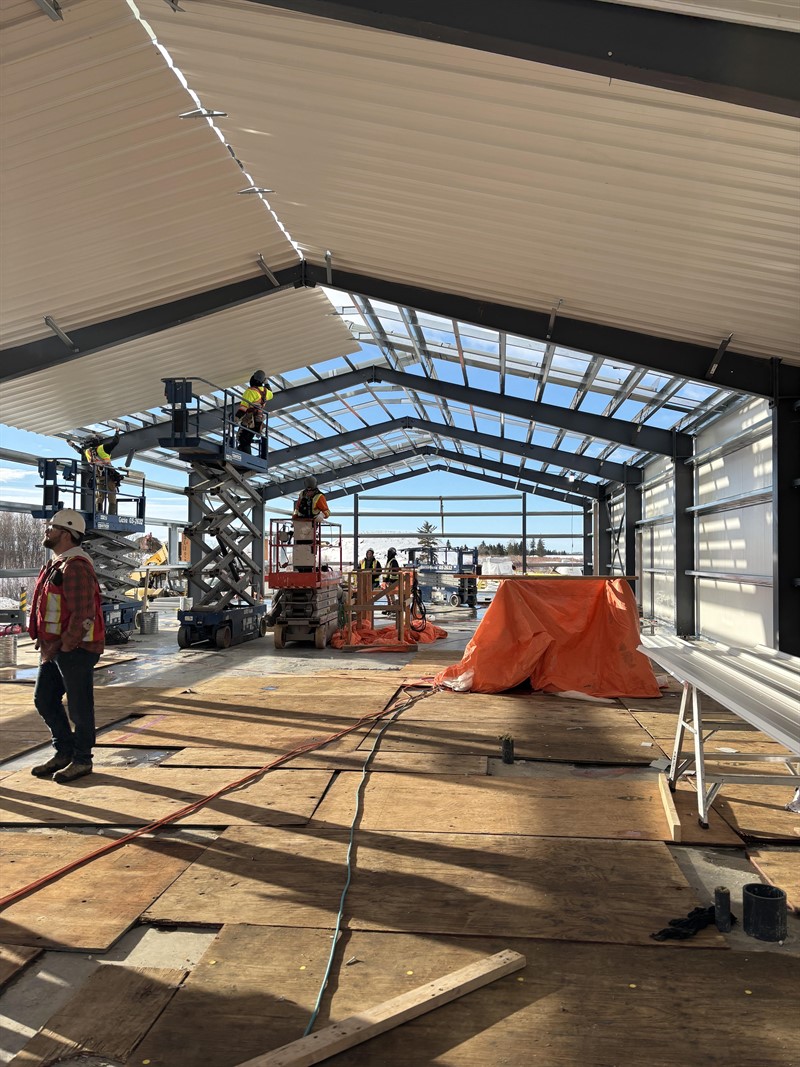

More progress has taken place at Rosthern’s new Water Treatment Plant. The steel framework is now fully in place, and roofing installation is well underway, marking a major milestone in the construction process.

Despite winter conditions, crews are making steady progress on site, keeping the project moving forward.

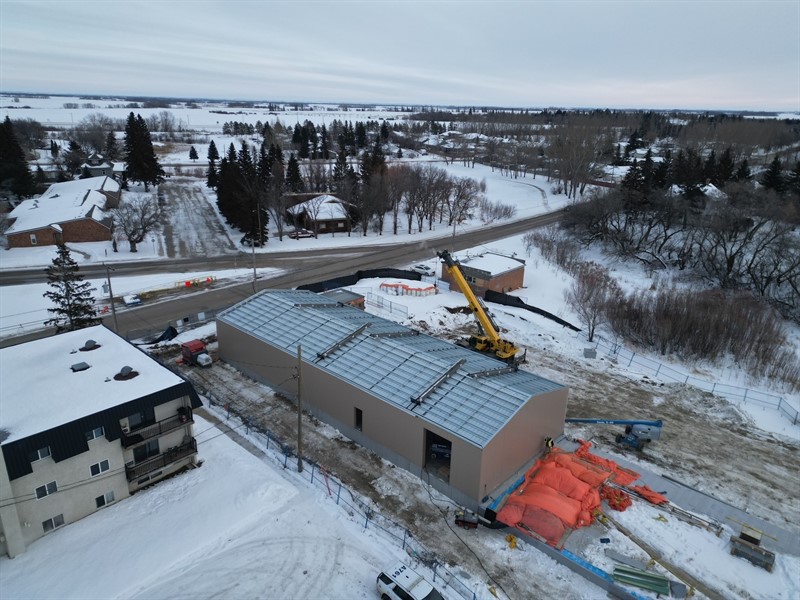

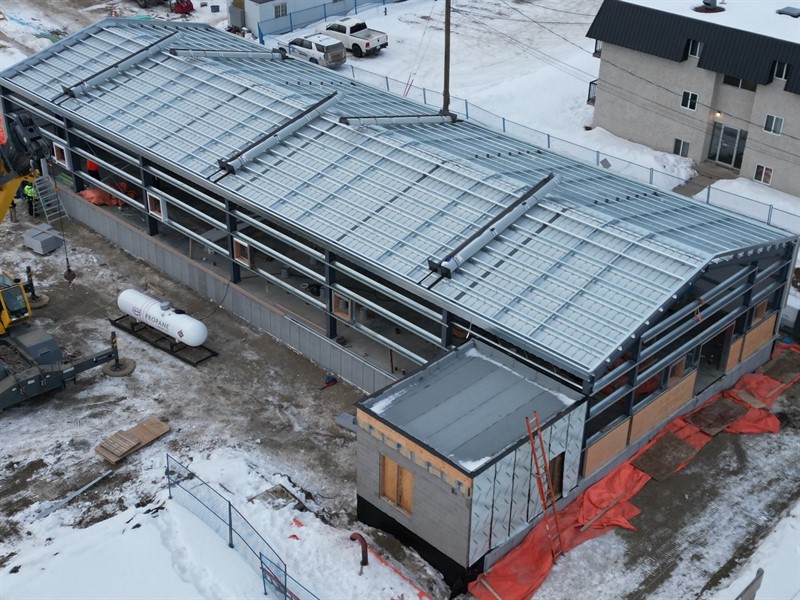

Roof Construction 1
Roof Construction 2
Roof Construction 3

All drone pictures supplied by Carolyn Rempel


January 13, 2026

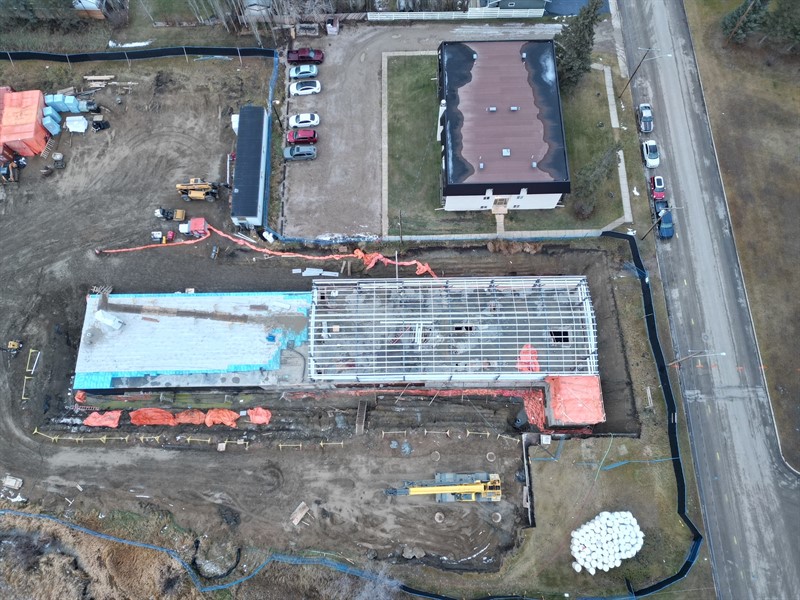

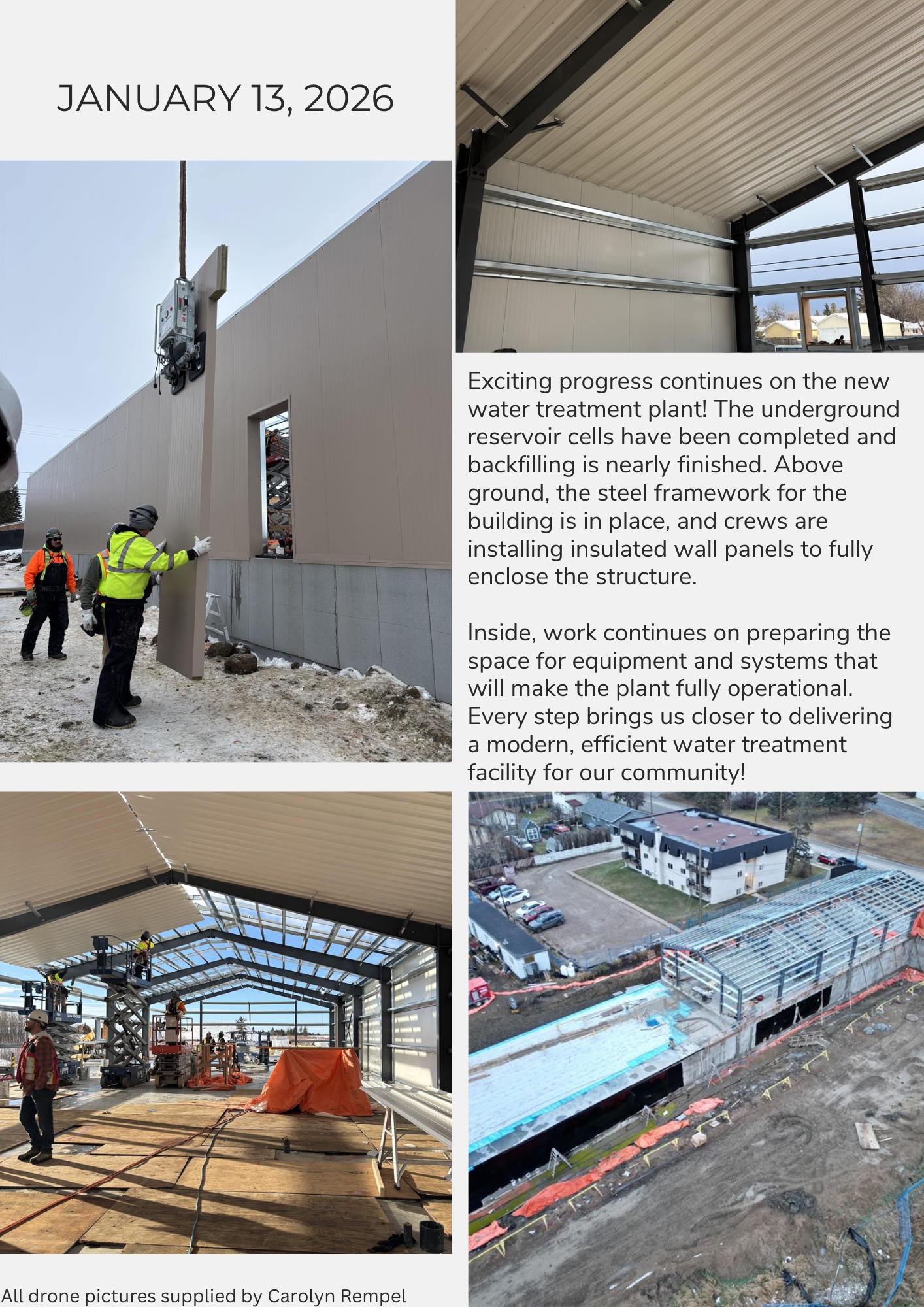

Walls Going Up! Water Treatment Plant Construction Update



Exciting progress continues on the new water treatment plant! The underground reservoir cells have been completed and backfilling is nearly finished. Above ground, the steel framework for the building is in place, and crews are installing insulated wall panels to fully enclose the structure.

Inside, work continues on preparing the space for equipment and systems that will make the plant fully operational. Every step brings us closer to delivering a modern, efficient water treatment facility for our community!

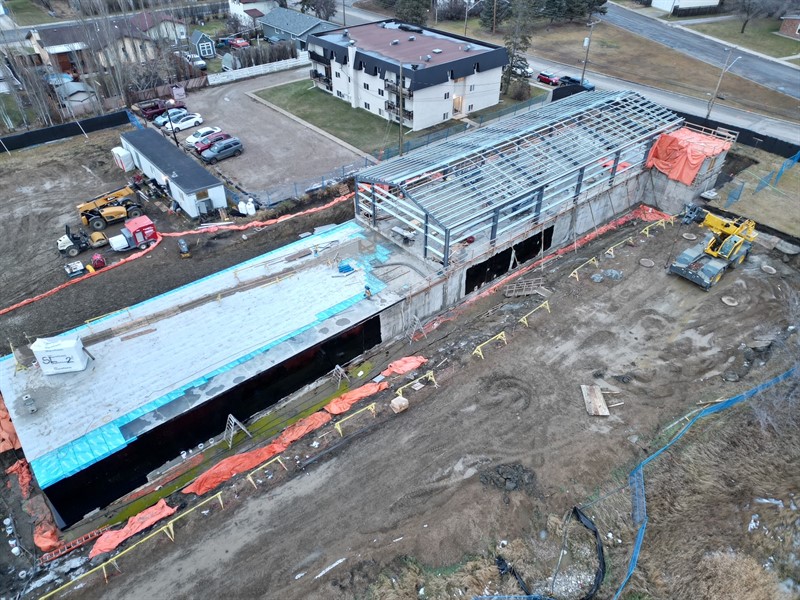

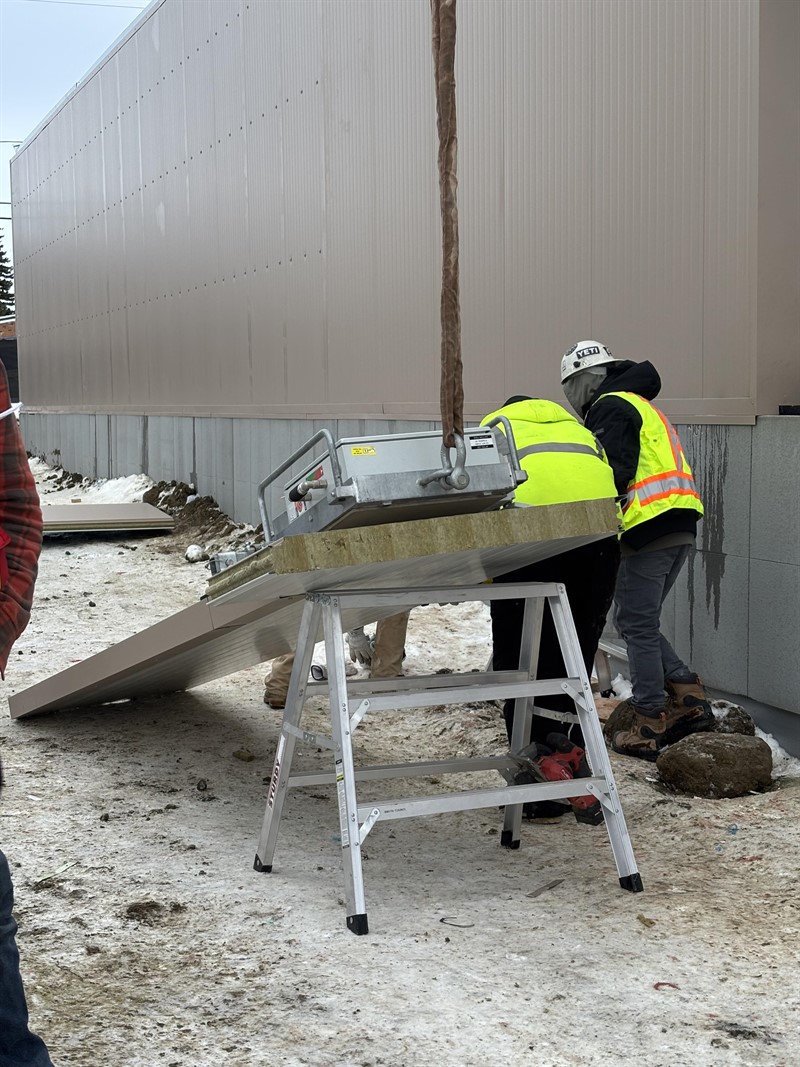

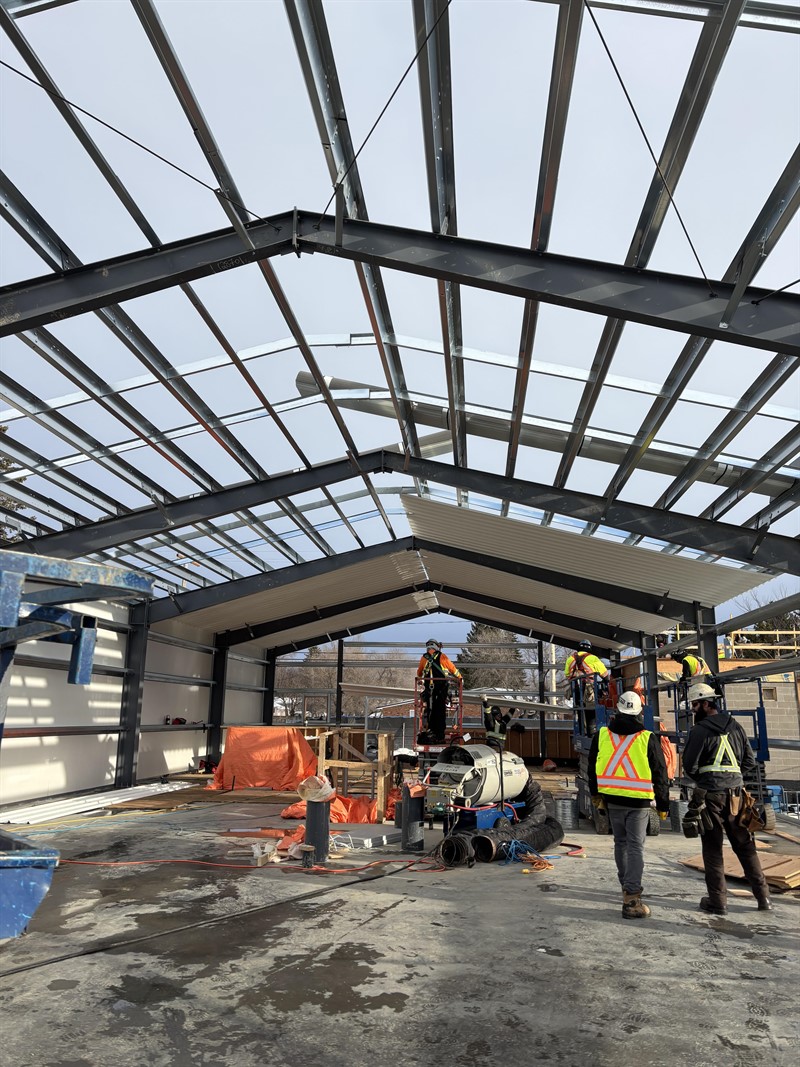

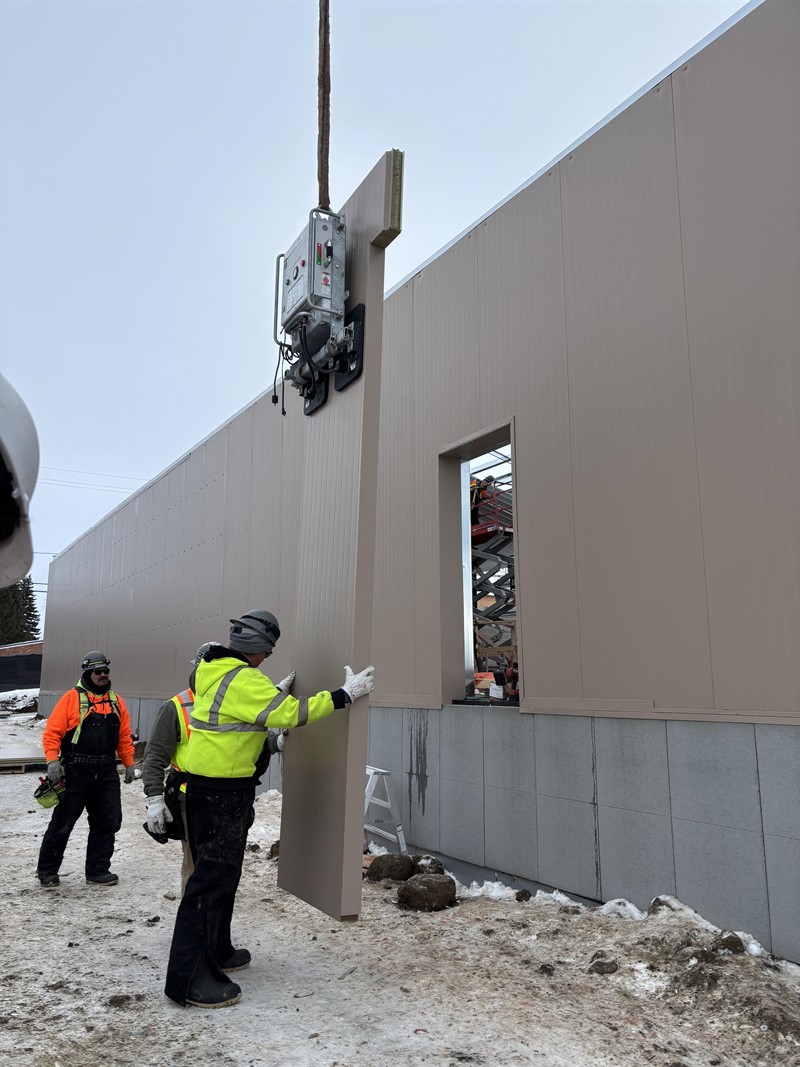

Water Treatment Plant Update 1
Water Treatment Plant Update 2
Water Treatment Plant Update 3
Water Treatment Plant Update 4
Water Treatment Plant Update 5
Water Treatment Plant Update 6
Water Treatment Plant Update 7
Water Treatment Plant Update 8
All drone pictures supplied by Carolyn Rempel



November 19, 2025


Our New Water Treatment Plant is Taking Shape

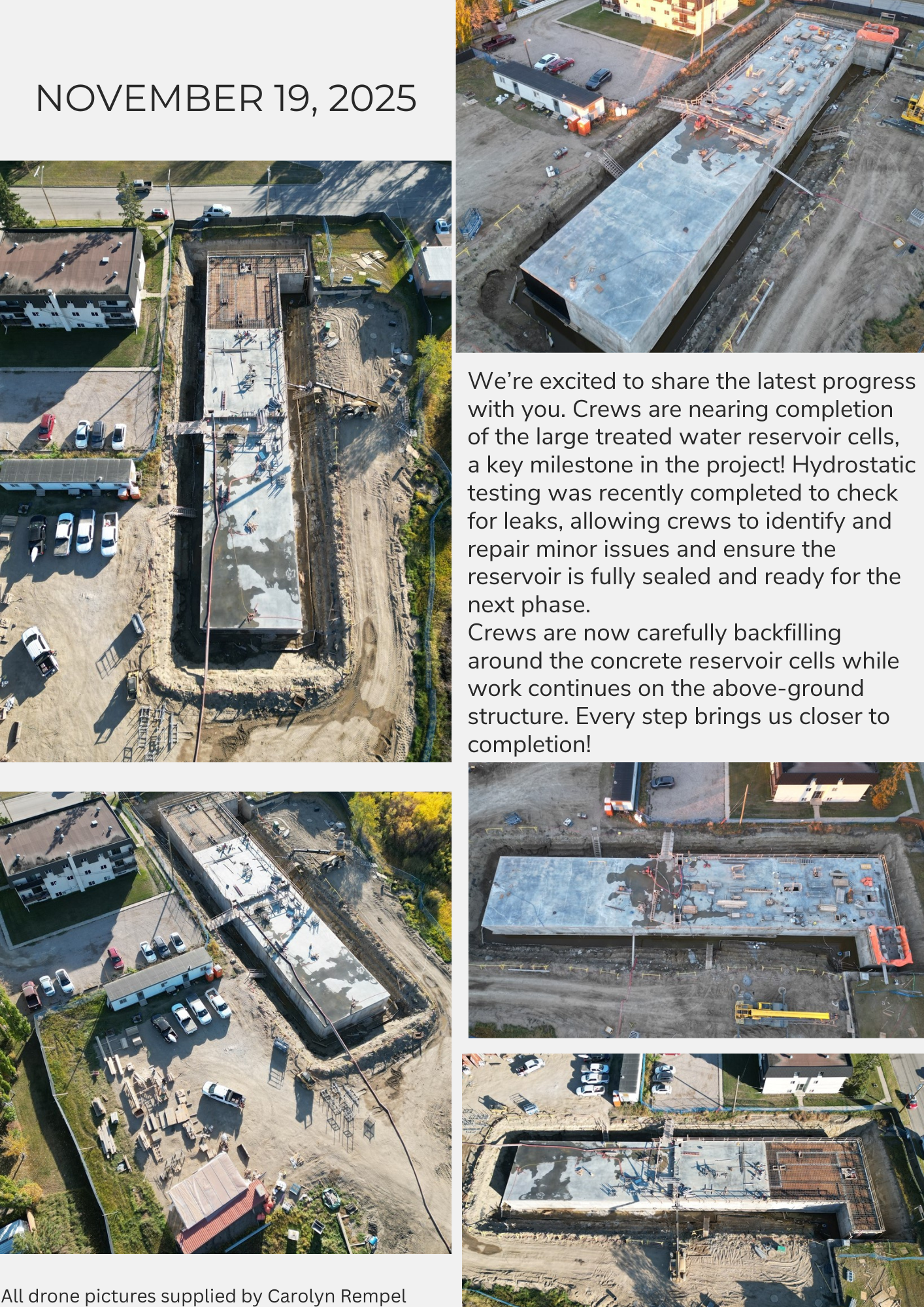

We’re excited to share the latest progress with you. Crews are nearing completion of the large treated water reservoir cells, a key milestone in the project! Hydrostatic testing was recently completed to check for leaks, allowing crews to identify and repair minor issues and ensure the reservoir is fully sealed and ready for the next phase.

Crews are now carefully backfilling around the concrete reservoir cells while work continues on the above-ground structure. Every step brings us closer to completion!

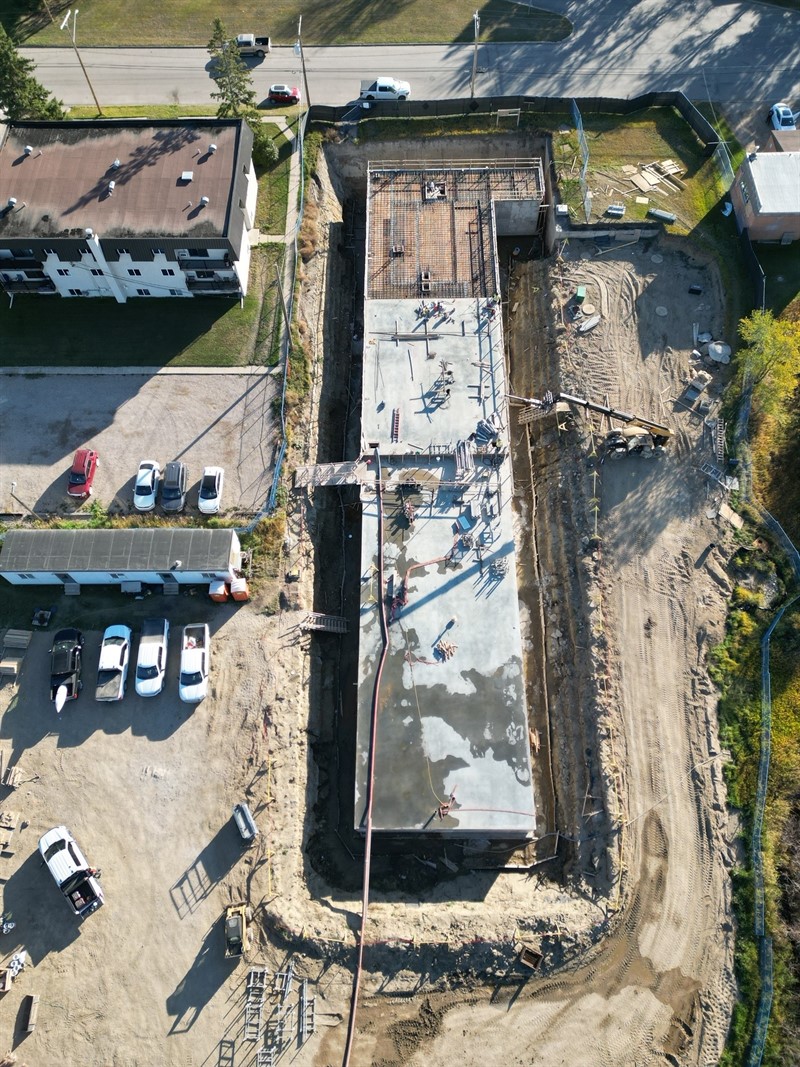

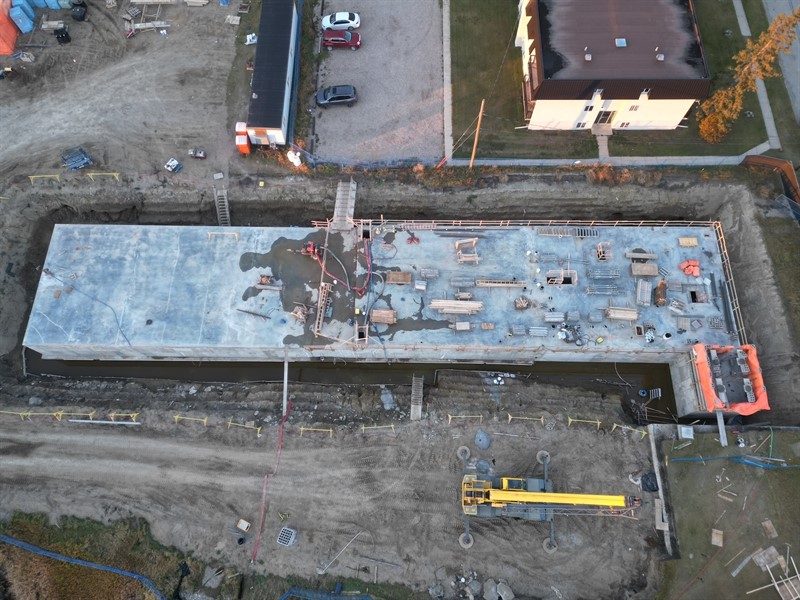

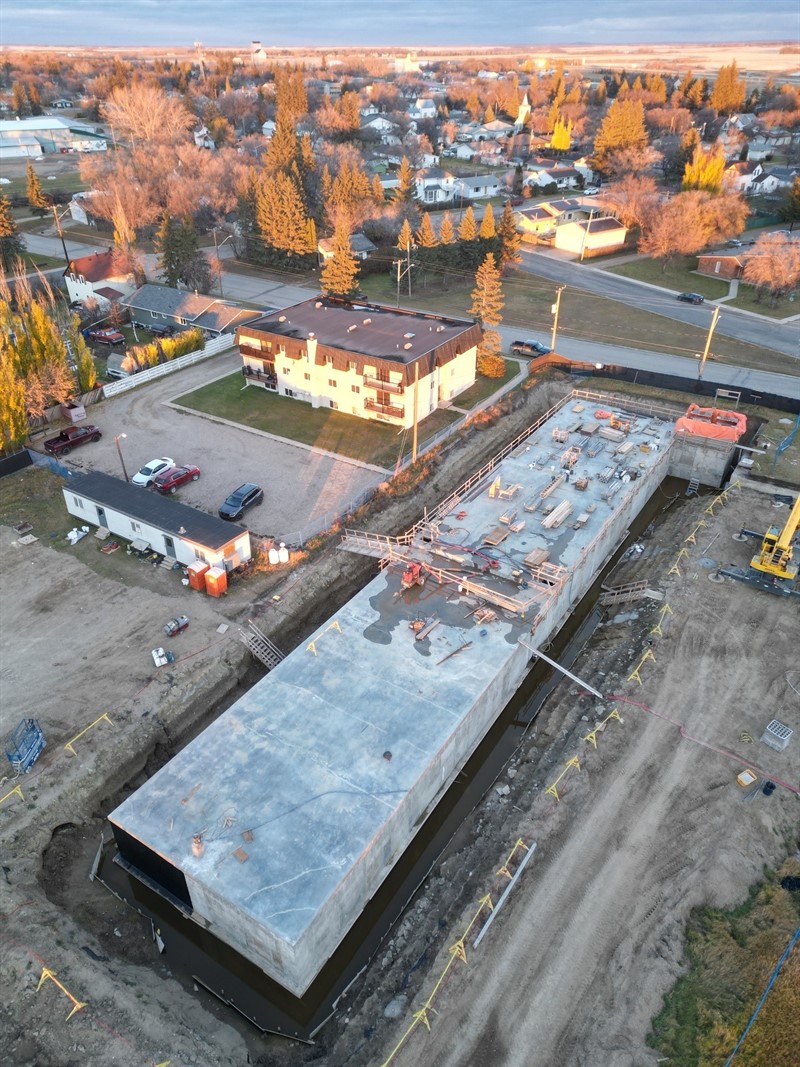

New Water Treatment Plant 1
New Water Treatment Plant 5

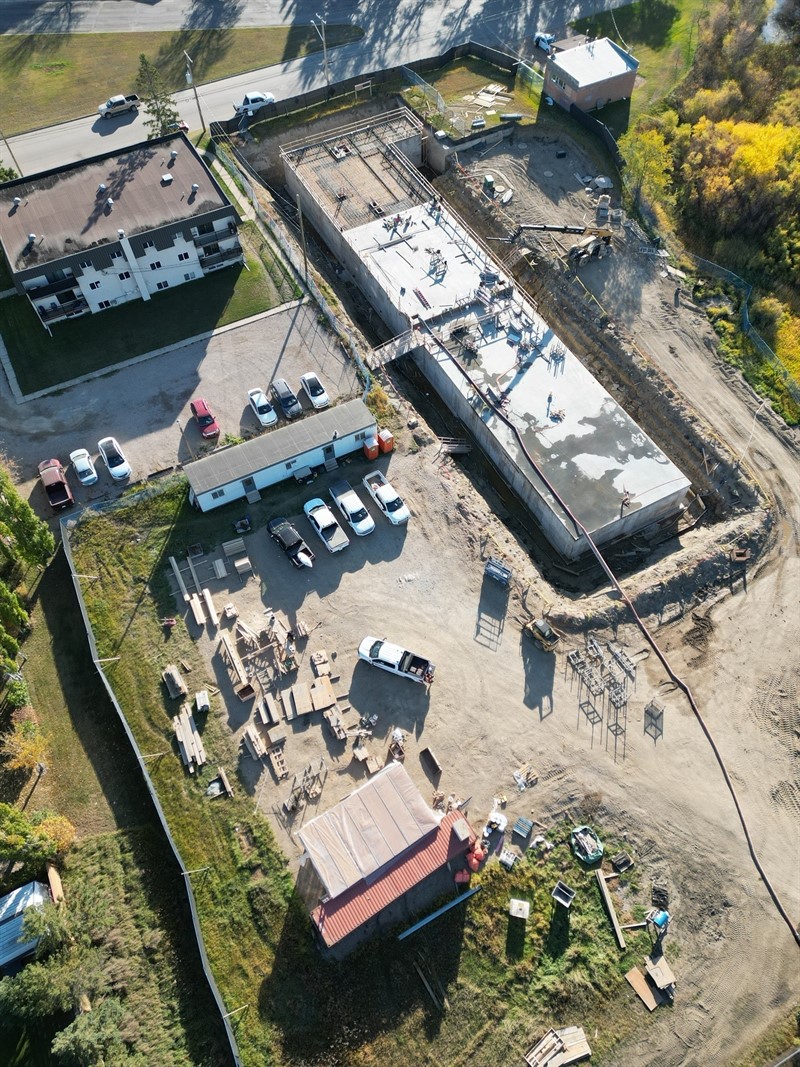

New Water Treatment Plant 3
New Water Treatment Plant 4

New Water Treatment Plant 6
All drone pictures supplied by Carolyn Rempel

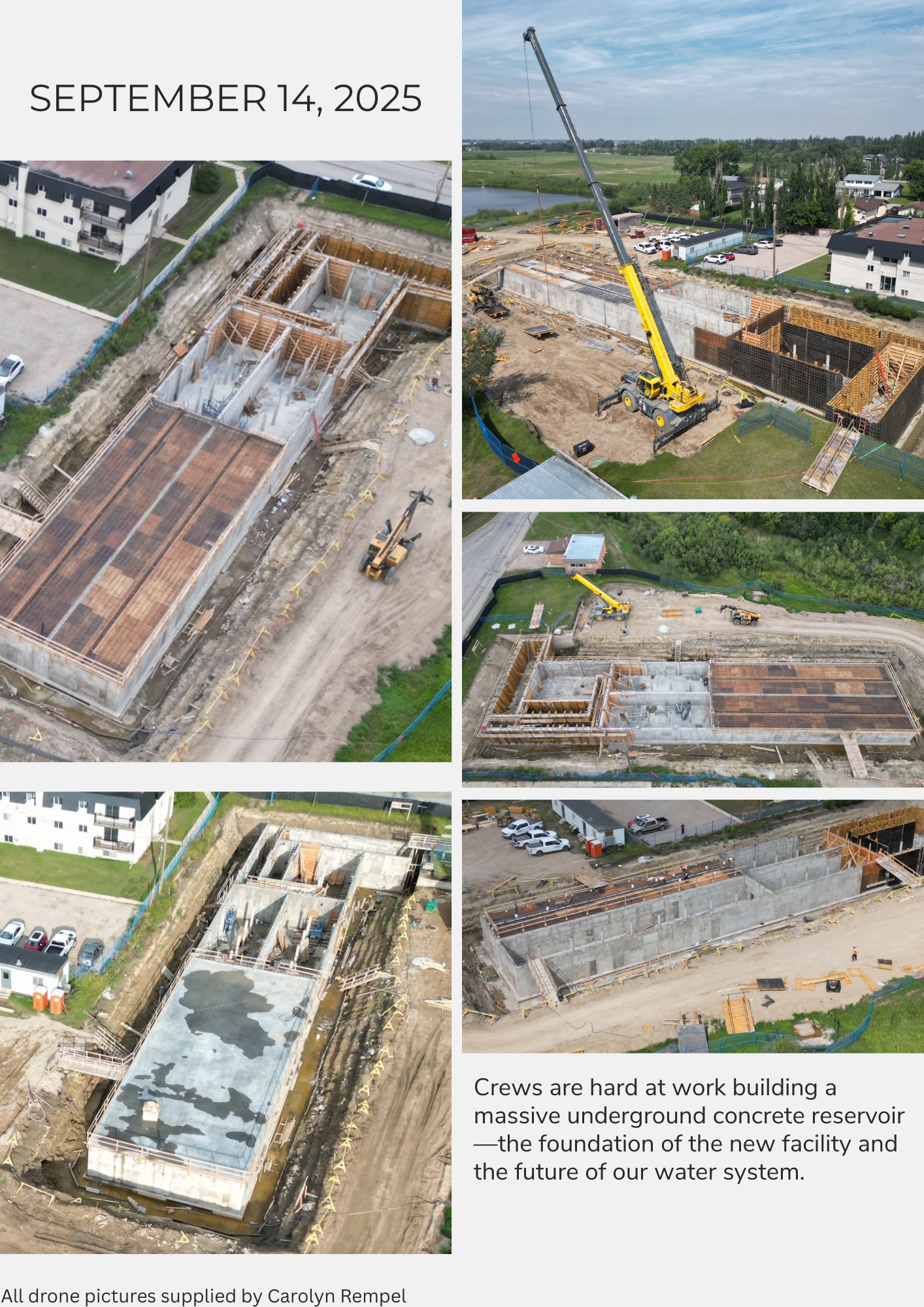

September 14, 2025


Plant Construction Continues


Our new Water Treatment Plant is taking shape, and we’re excited to share the progress with you! Right now, crews are hard at work building a massive underground concrete reservoir—the foundation of the new facility and the future of our water system.

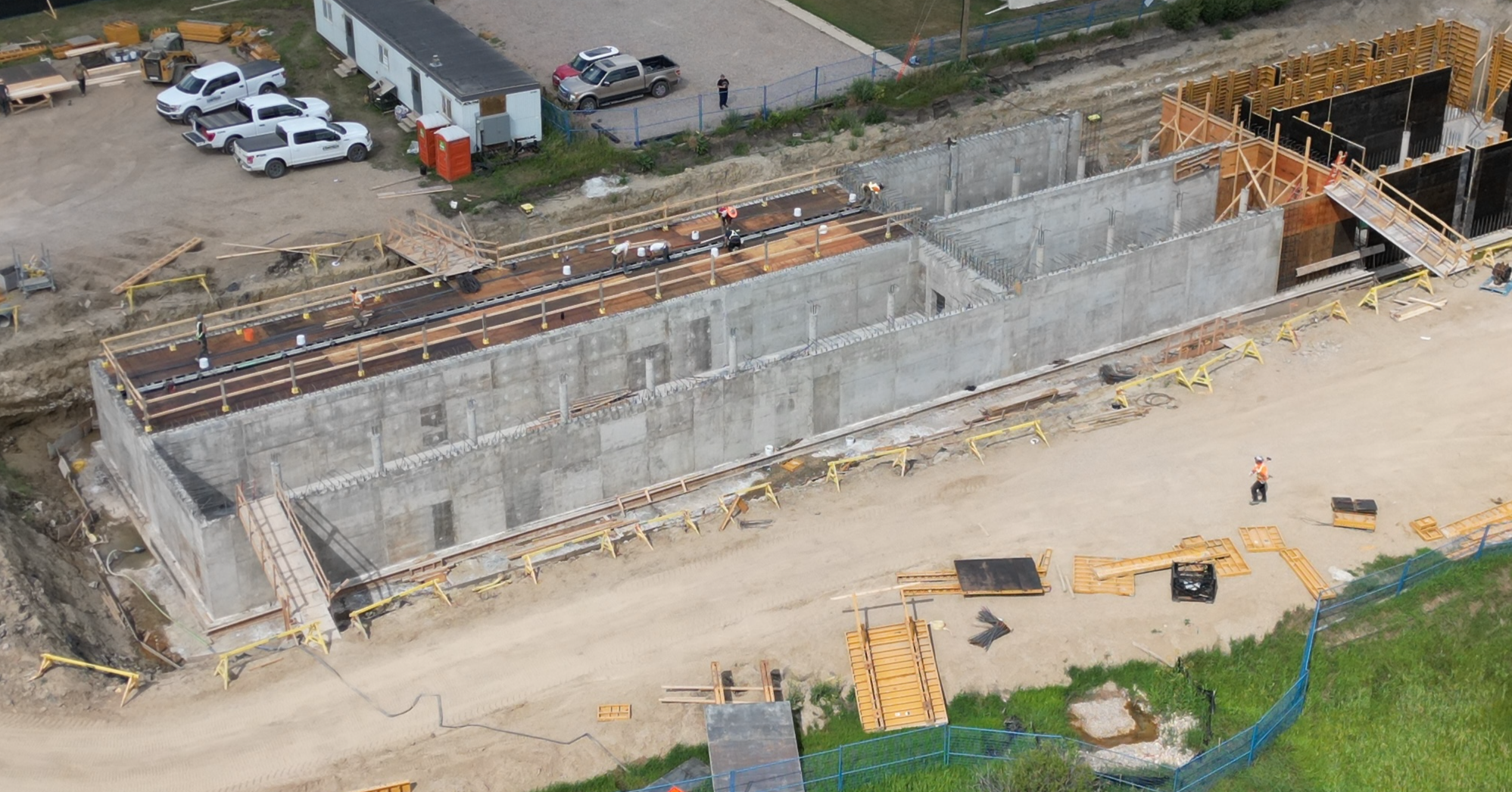

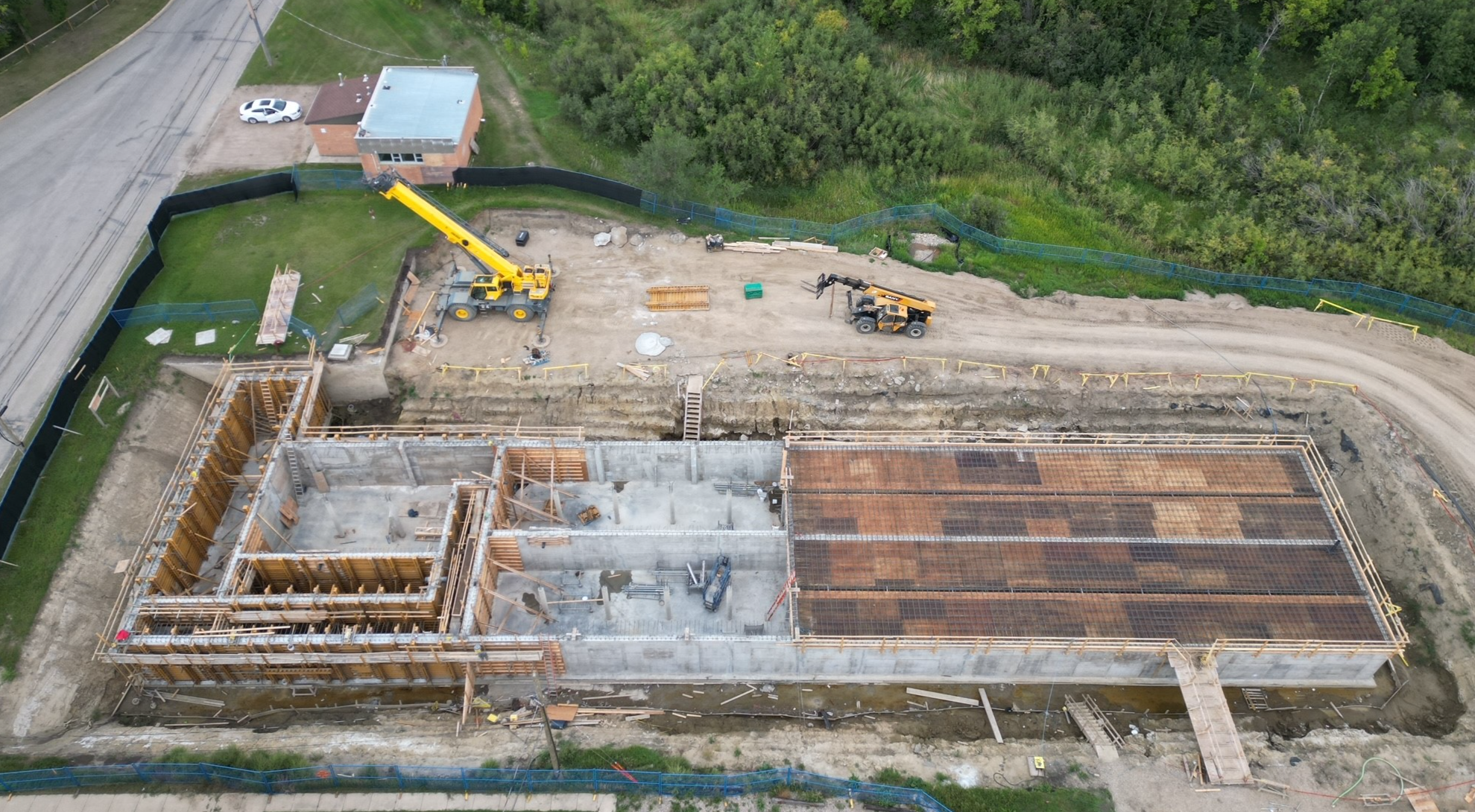

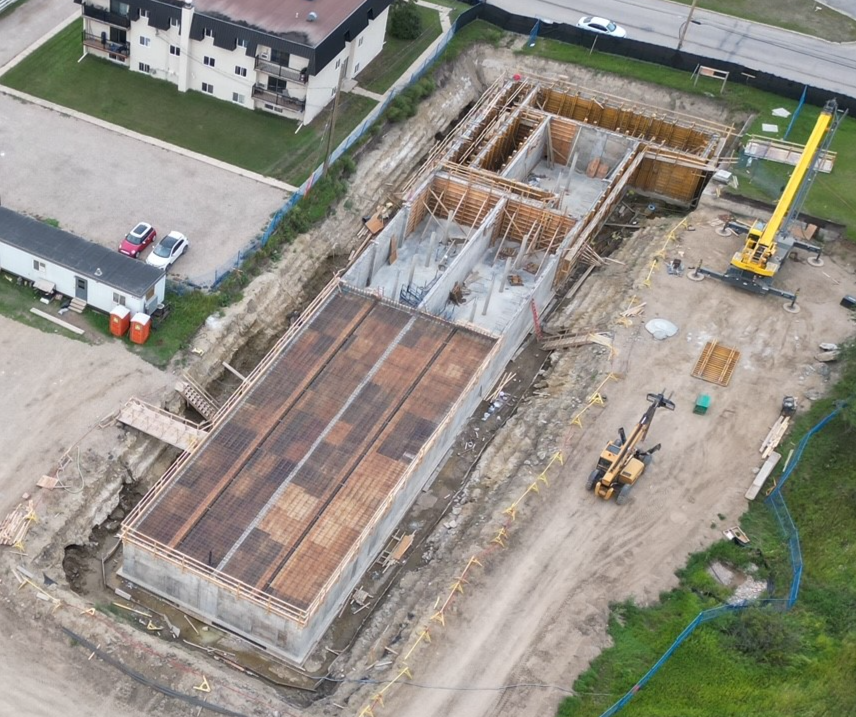

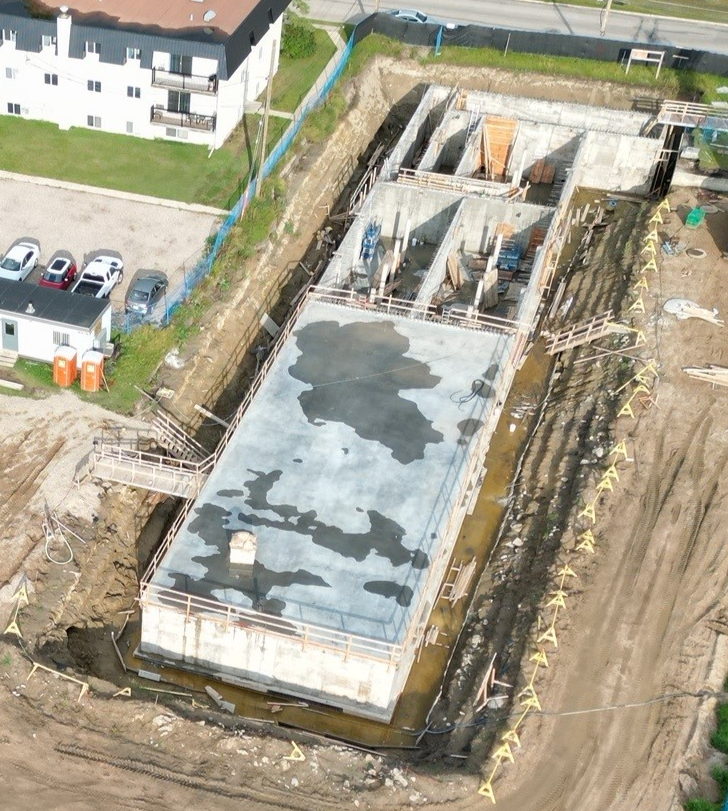

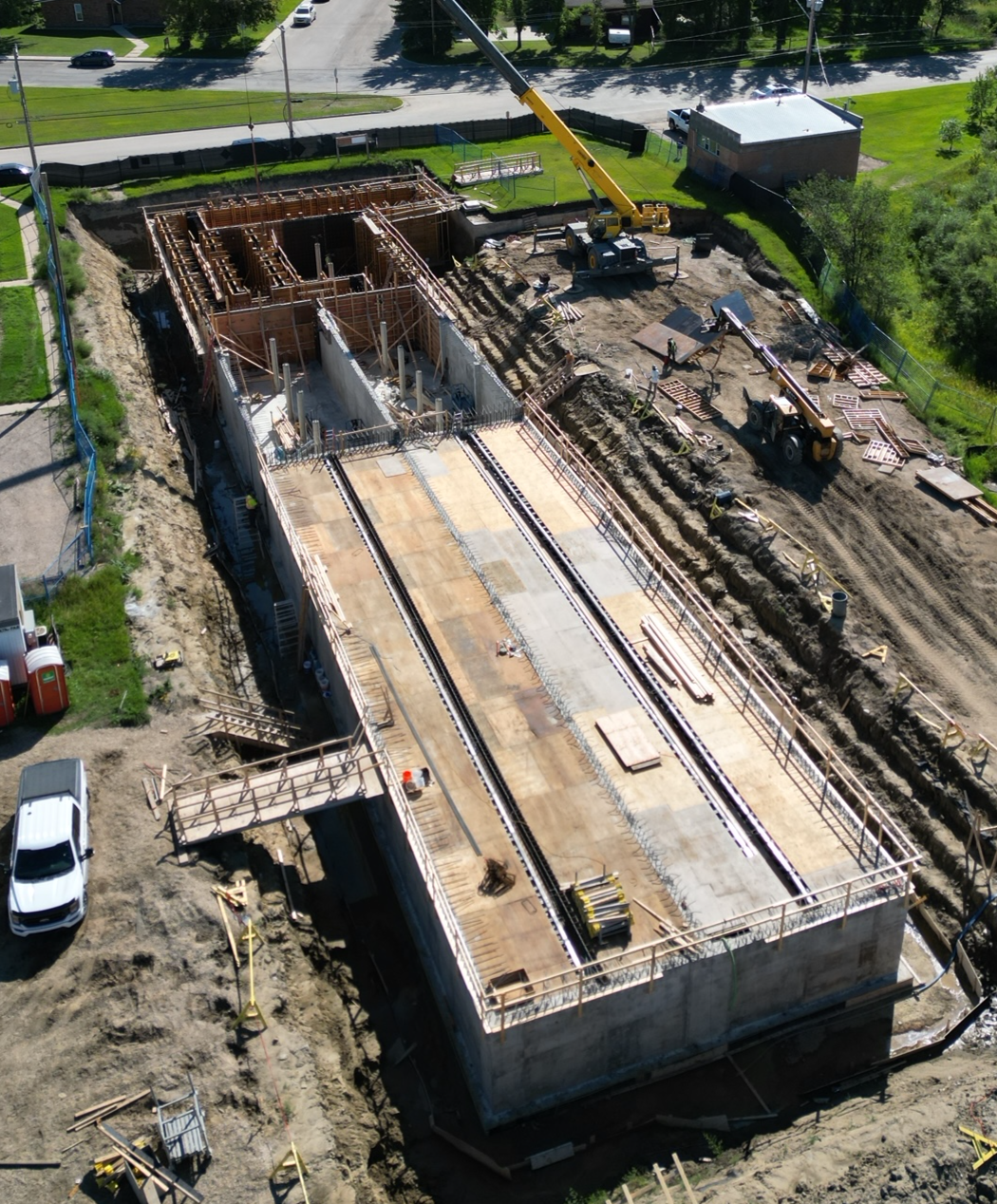

Plant Constructions 1 Plant Construction 2 Plant Construction 3
Plant Construction 4 Plant Construction 5 Plant Construction 6

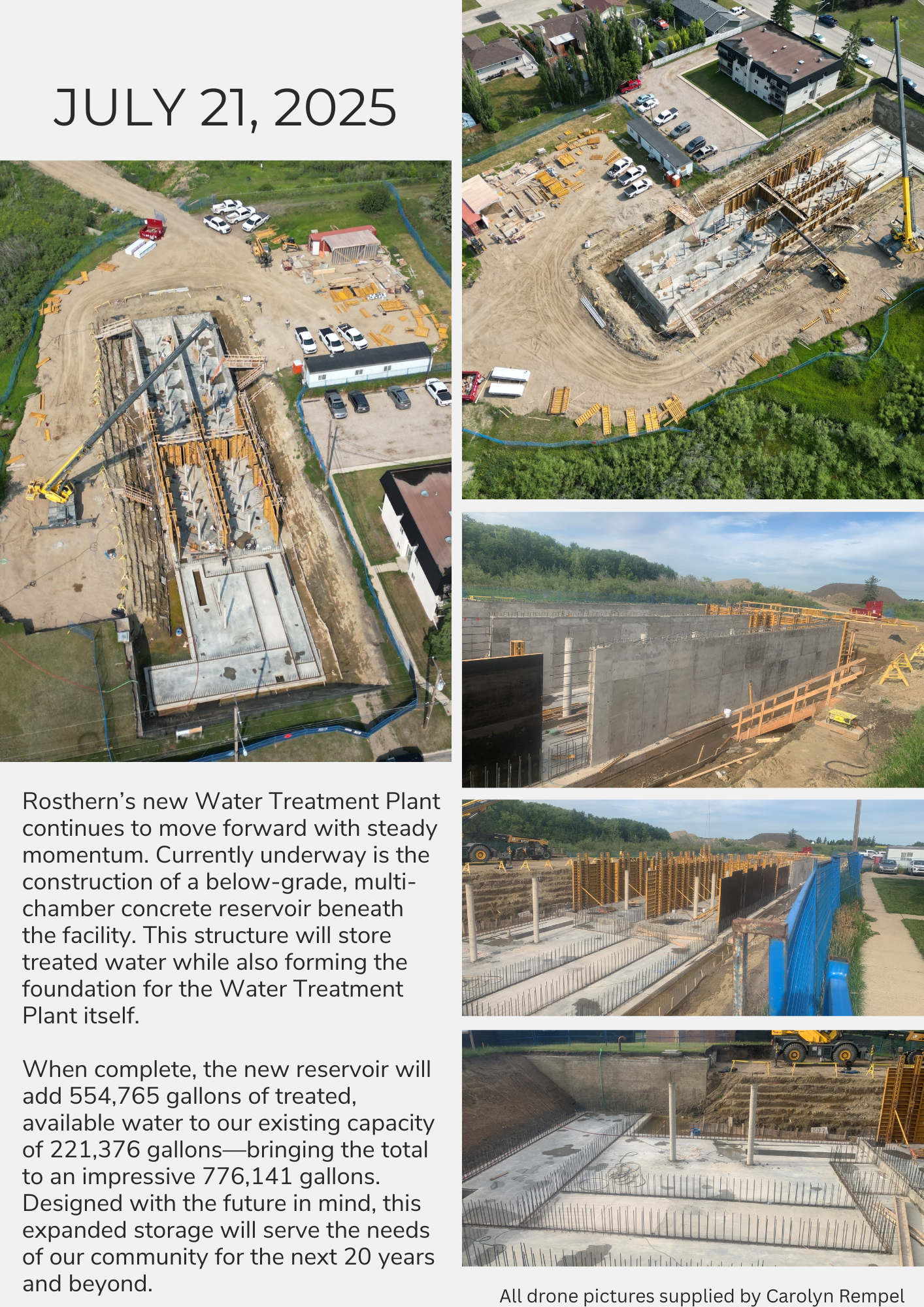

July 21, 2025

Building a Stronger Future – Water Treatment Plant Progress

Rosthern’s new Water Treatment Plant continues to move forward with steady momentum. Currently underway is the construction of a below-grade, multi-chamber concrete reservoir beneath the facility. This structure will store treated water while also forming the foundation for the Water Treatment Plant itself.

When complete, the new reservoir will add 554,765 gallons of treated, available water to our existing capacity of 221,376 gallons—bringing the total to an impressive 776,141 gallons. Designed with the future in mind, this expanded storage will serve the needs of our community for the next 20 years and beyond.

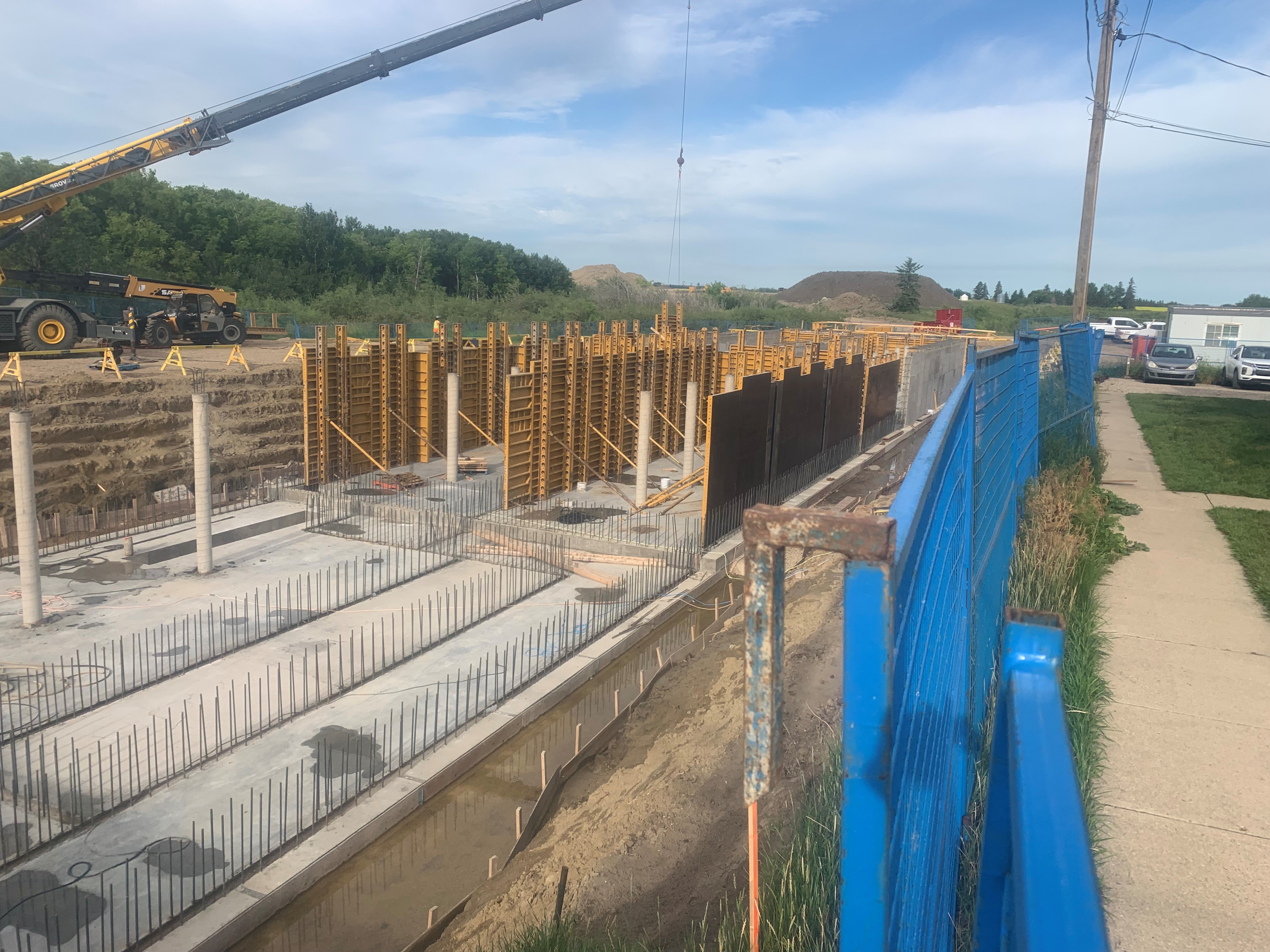

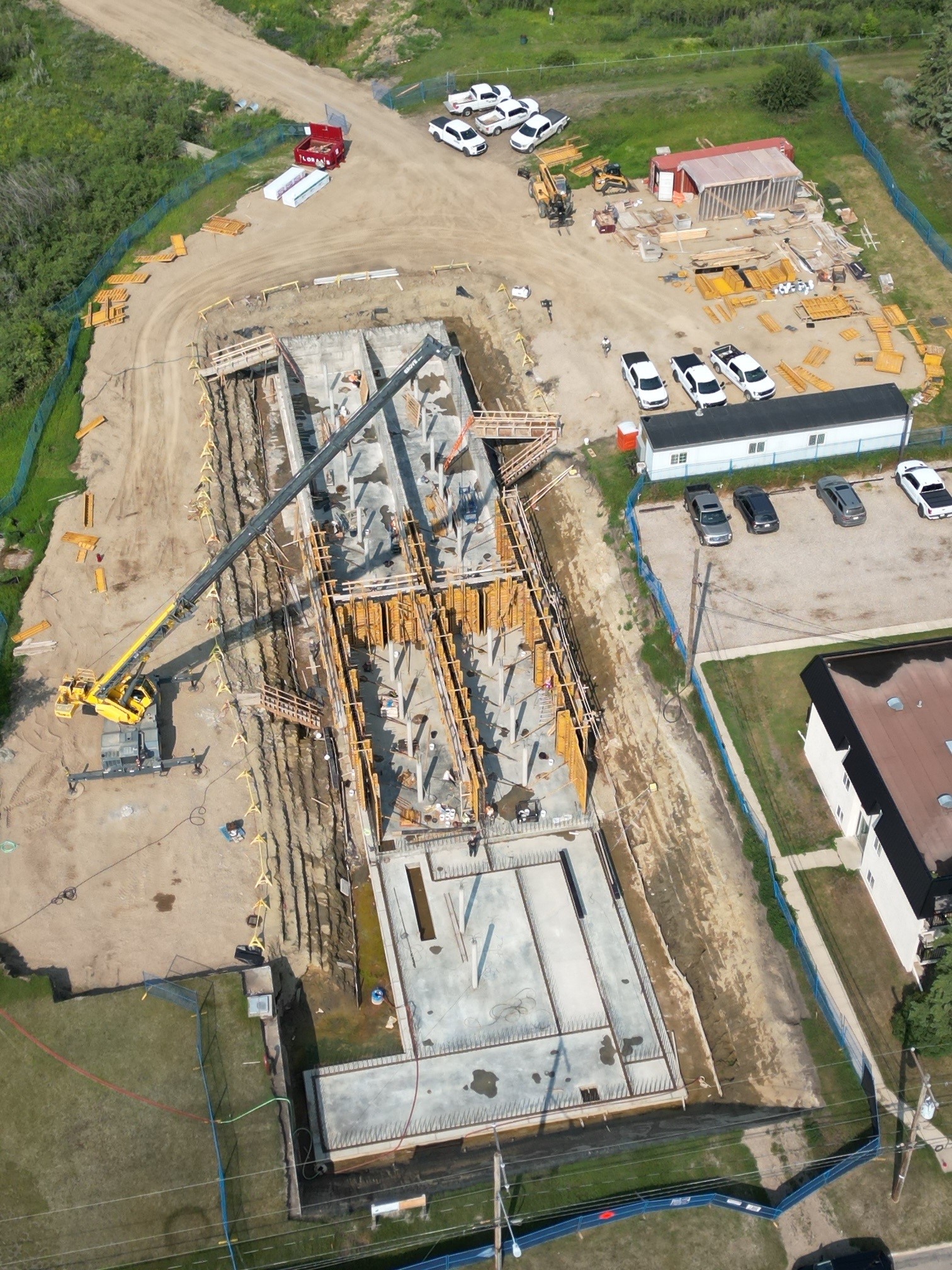

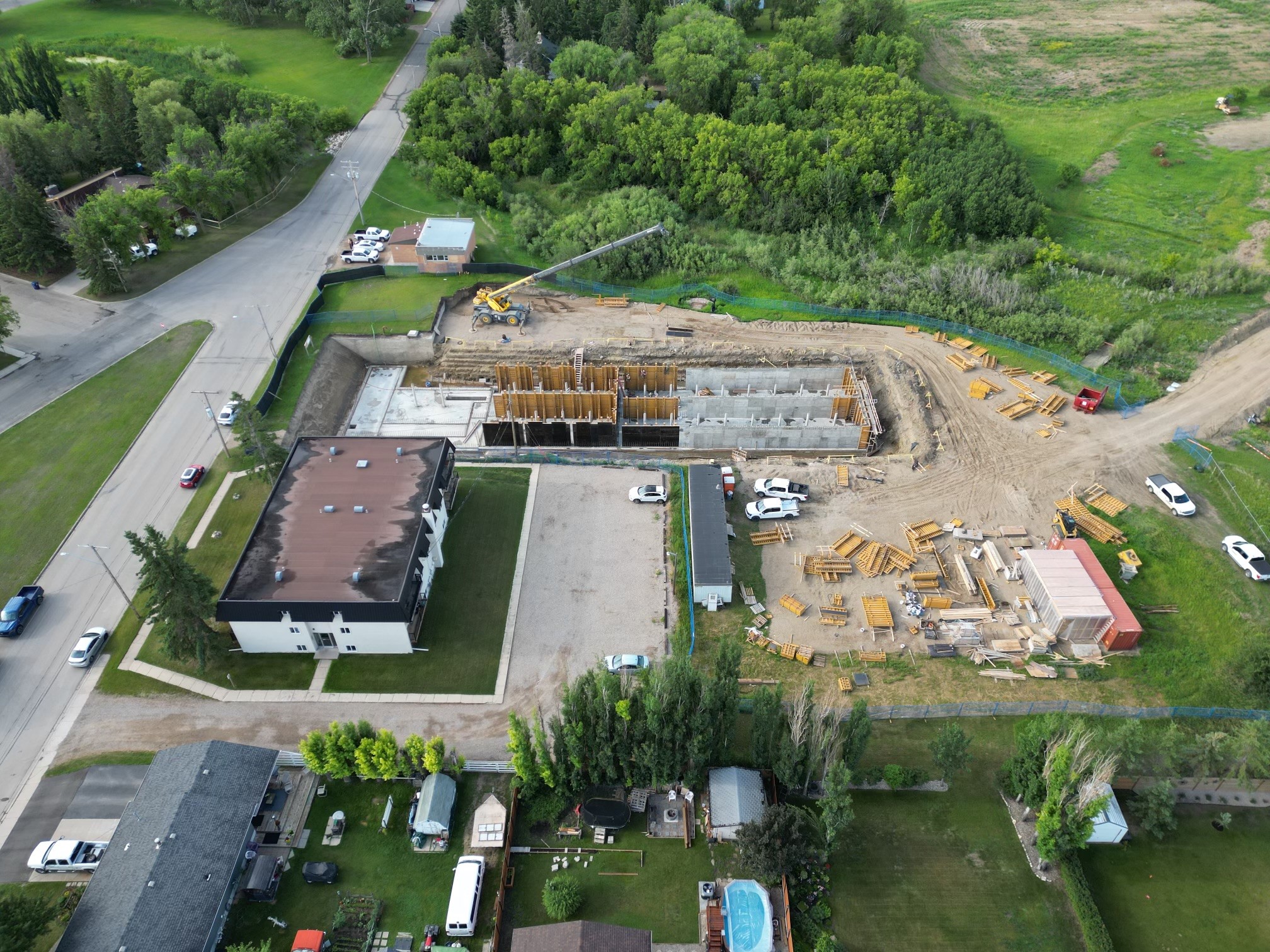

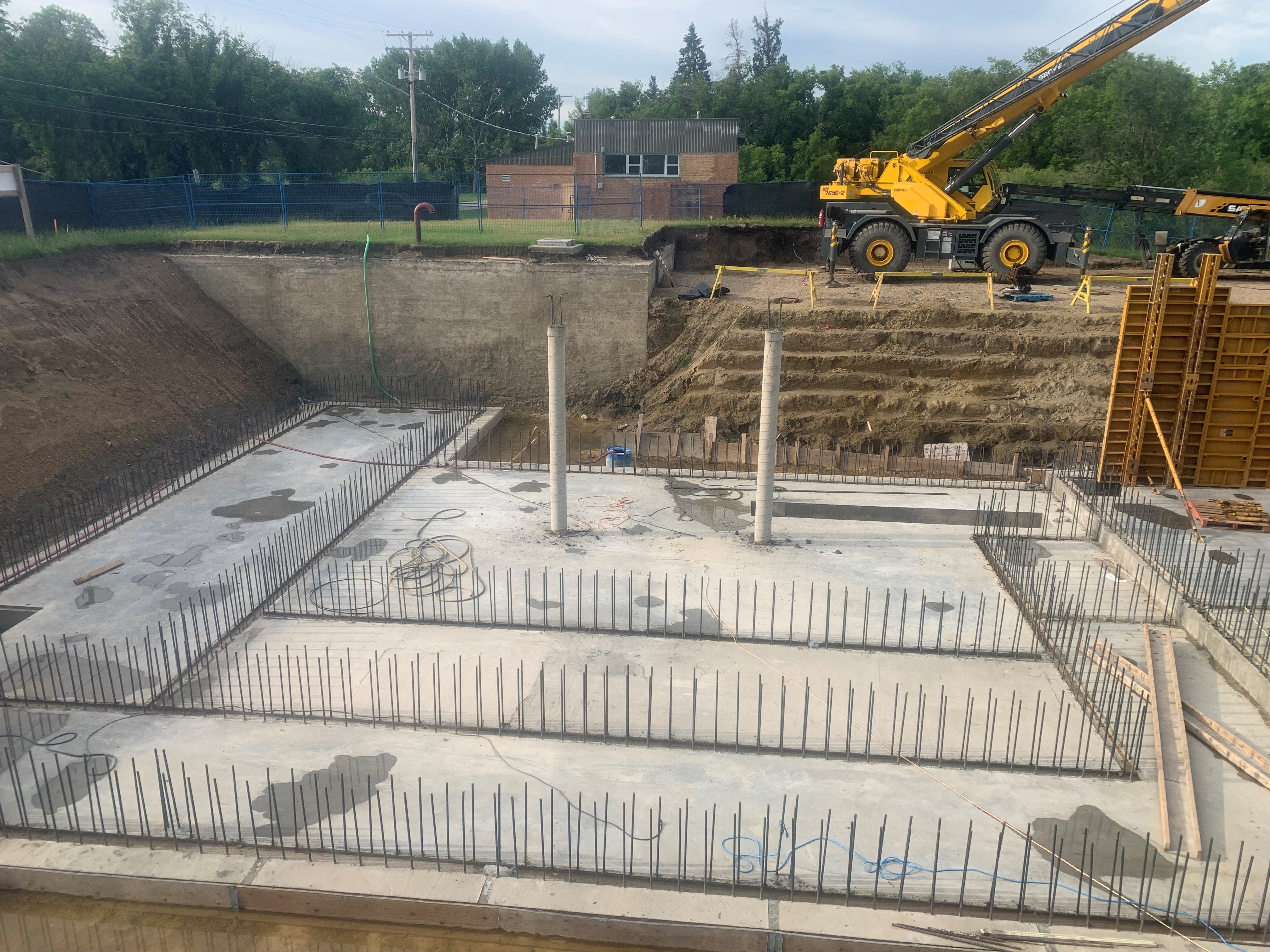

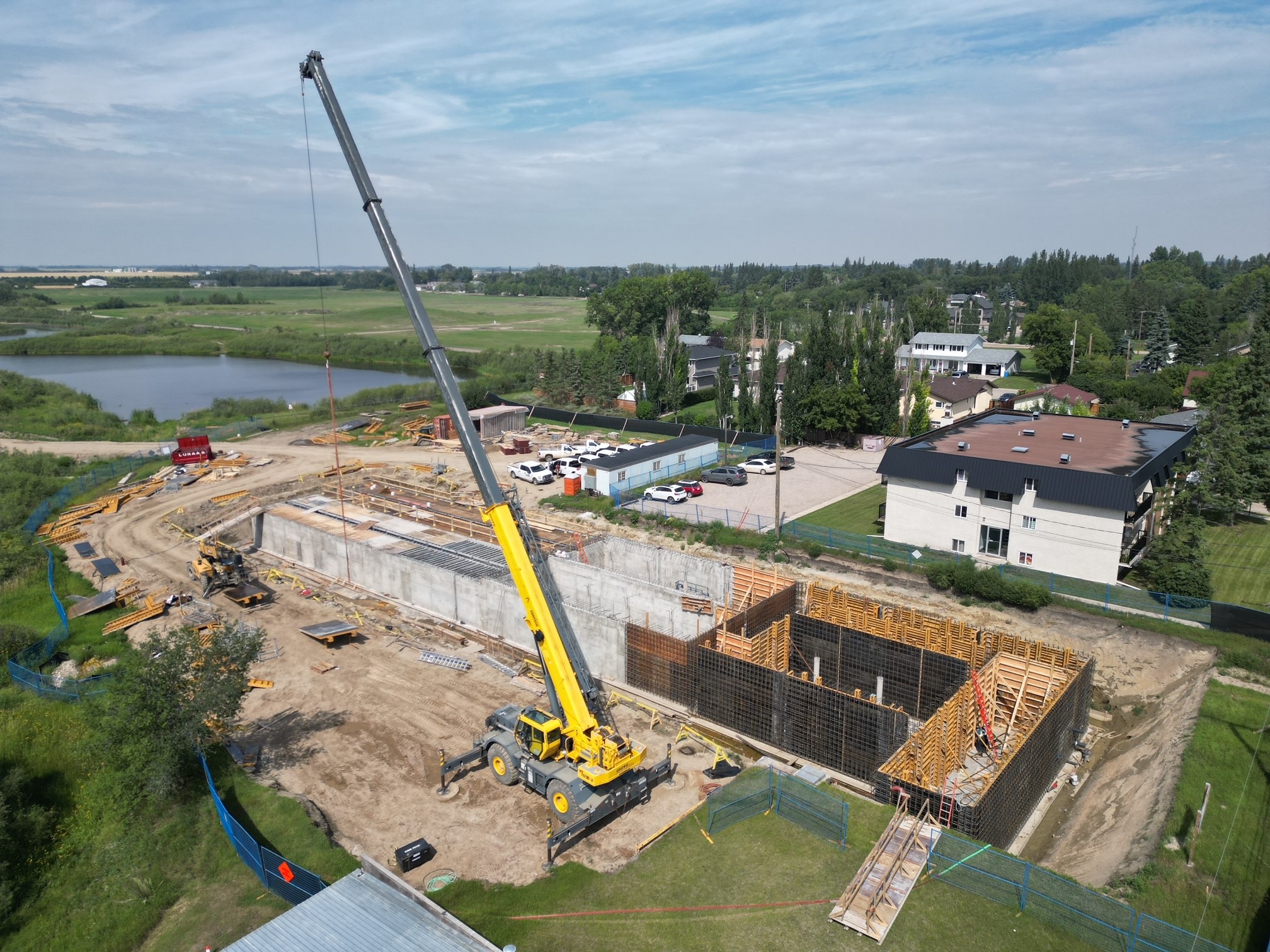

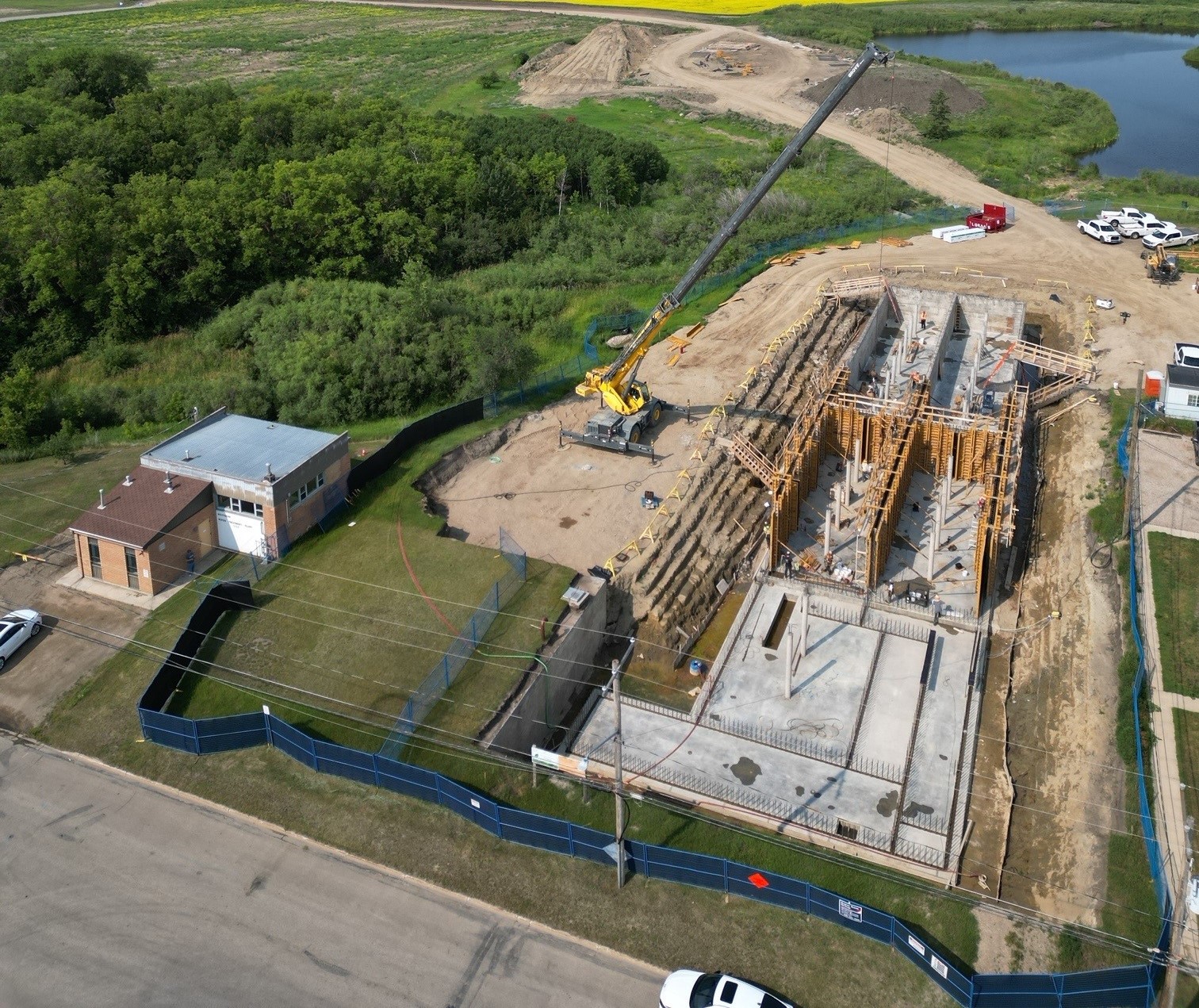

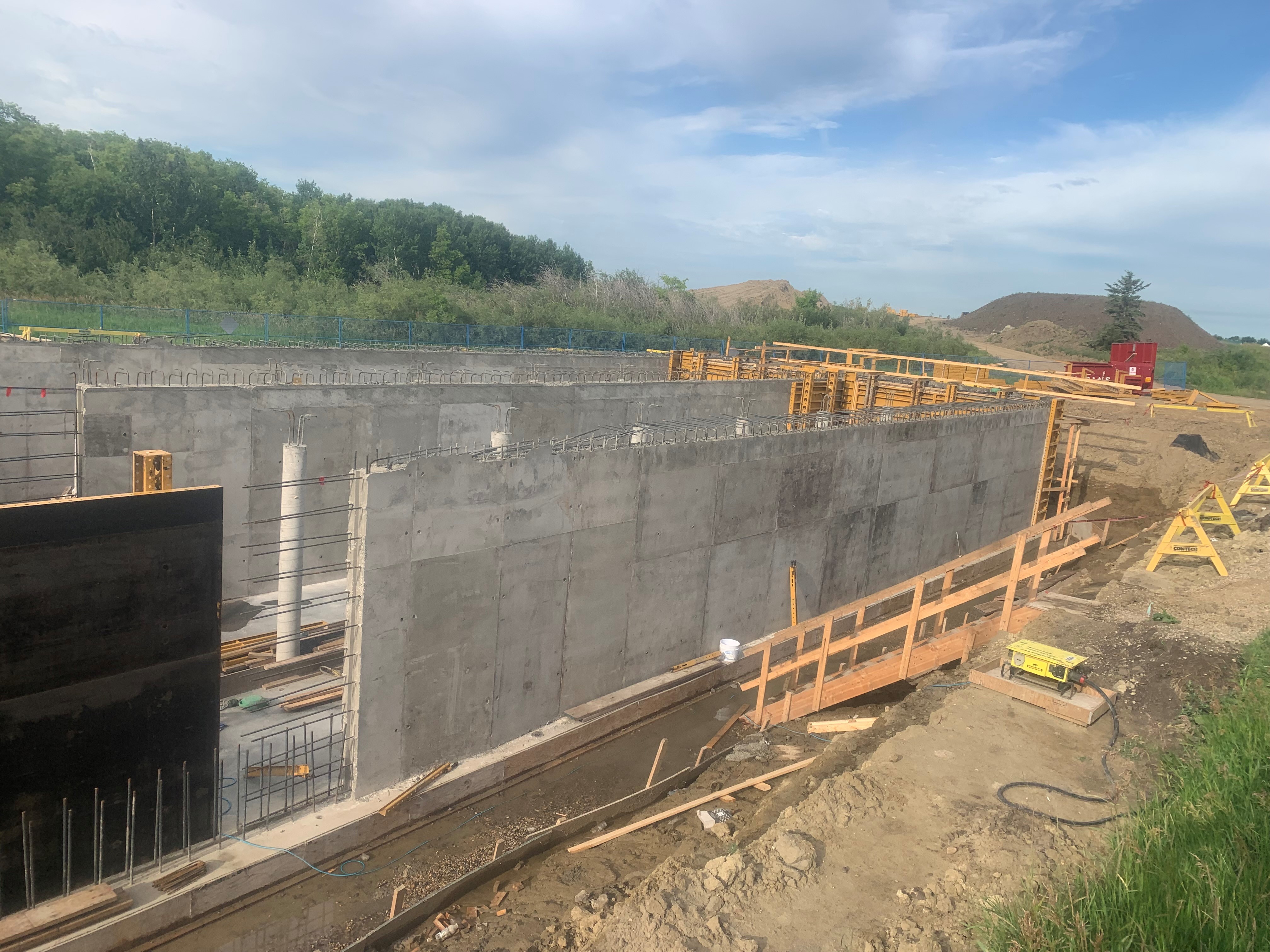

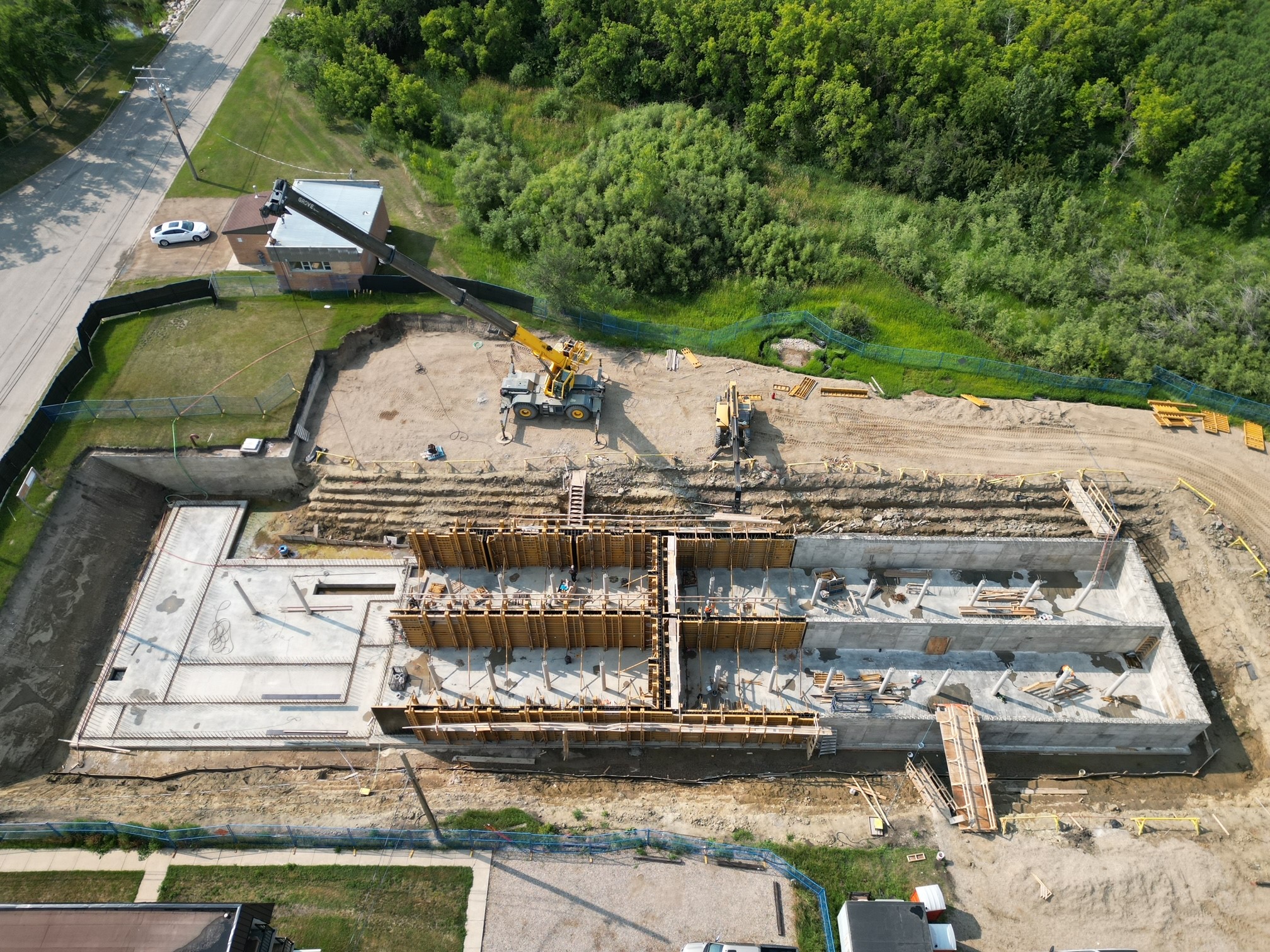

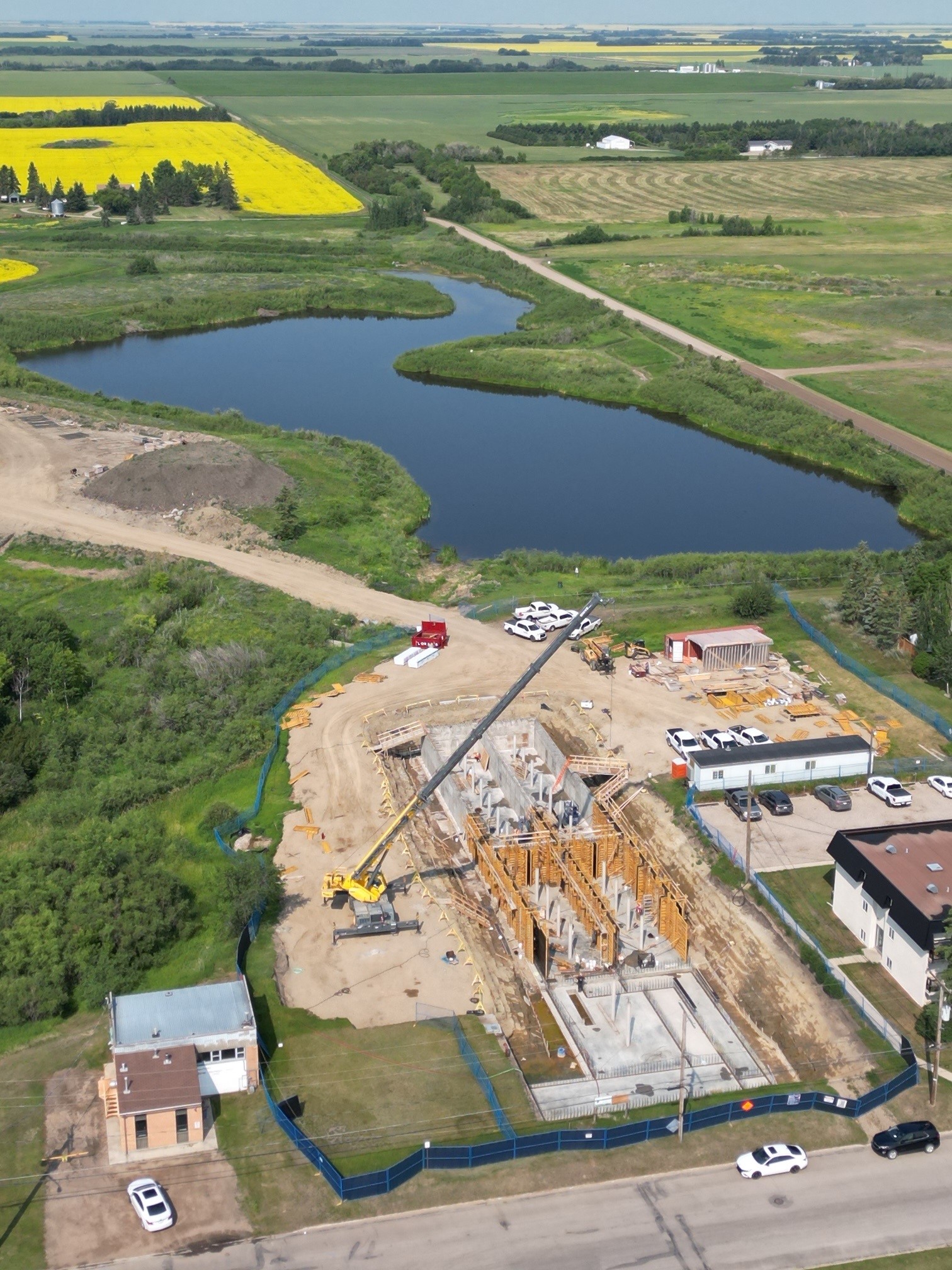

Plant Construction Progress 1 Plant Construction Progress 2 Plant Construction Progress 3

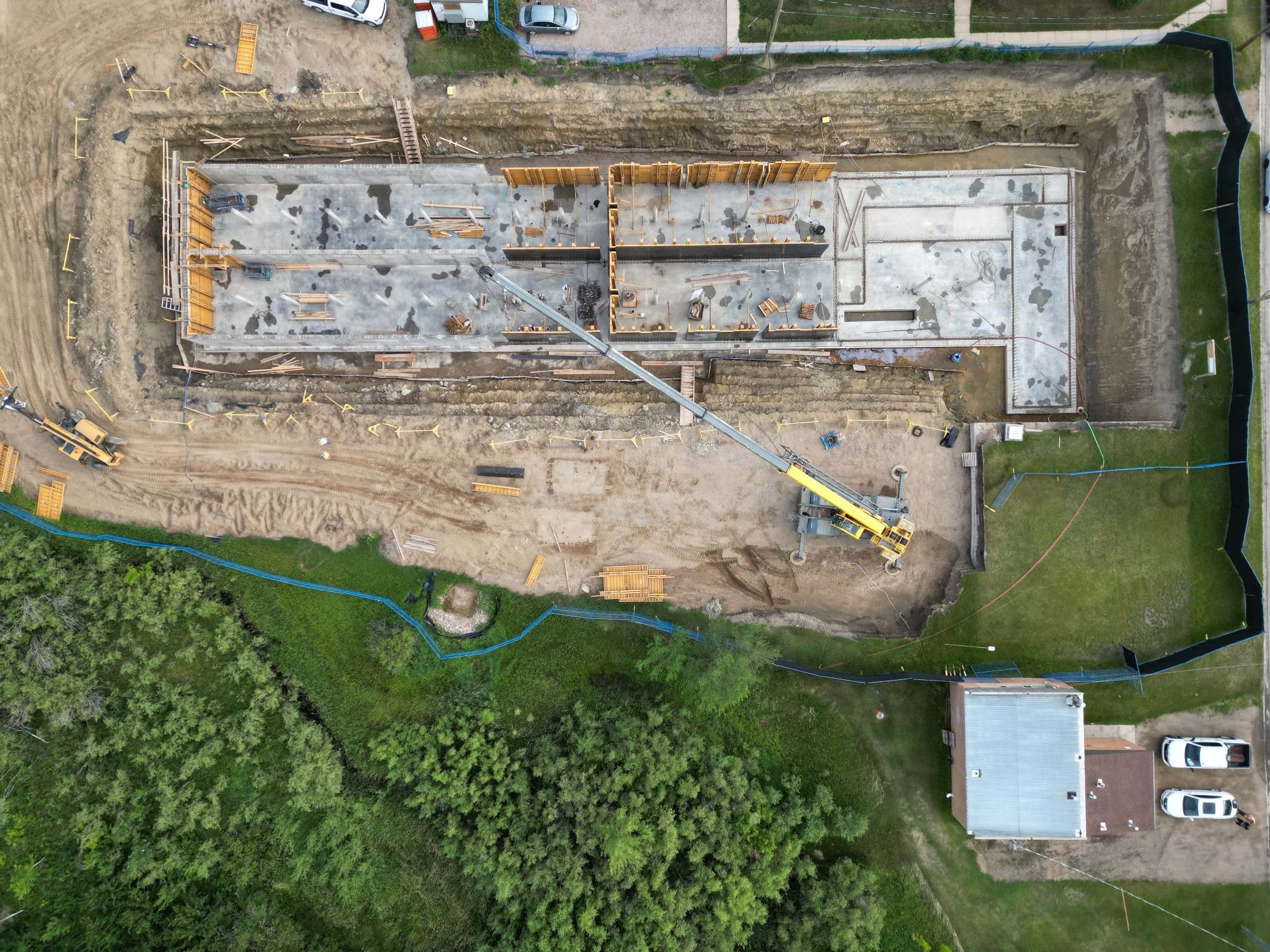

Plant Construction Progress 4 Plant Construction Progress 5 Plant Construction Progress 6
Plant Construction Progress 7 Plant Construction Progress 8 Plant Construction Progress 9

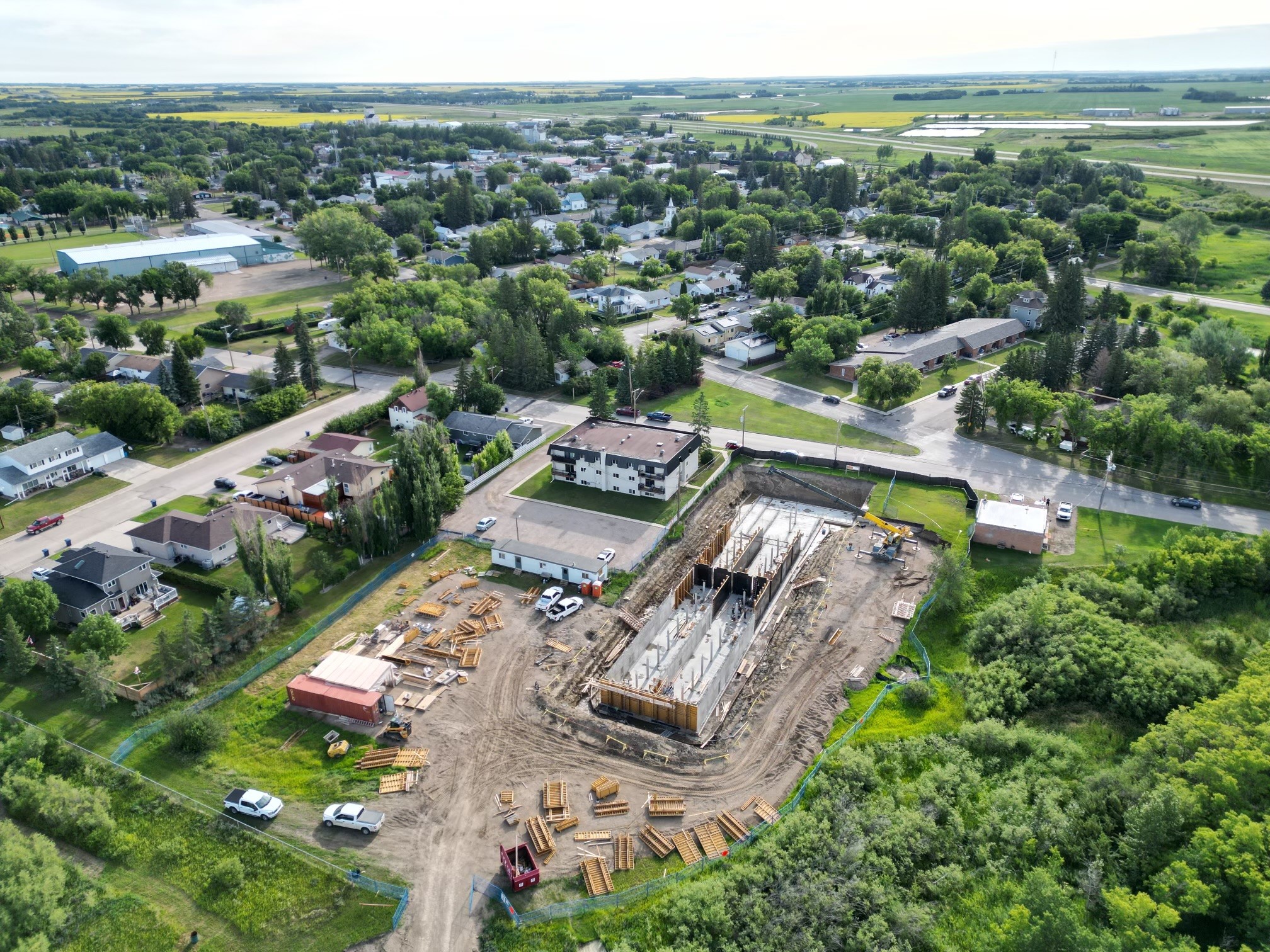

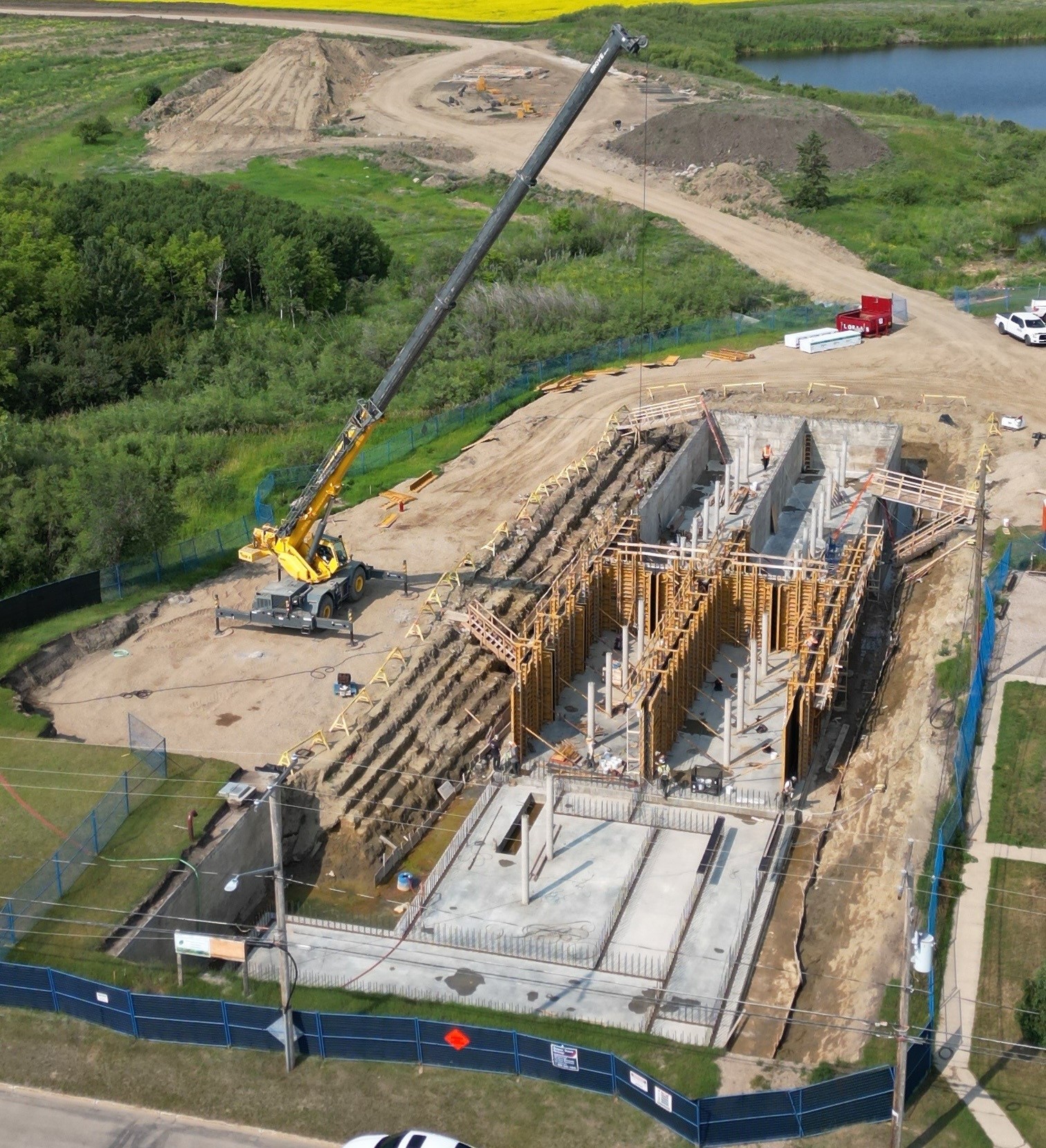

Plant Construction Progress 10 Plant Construction Progress 11 Plant Construction Progress 12

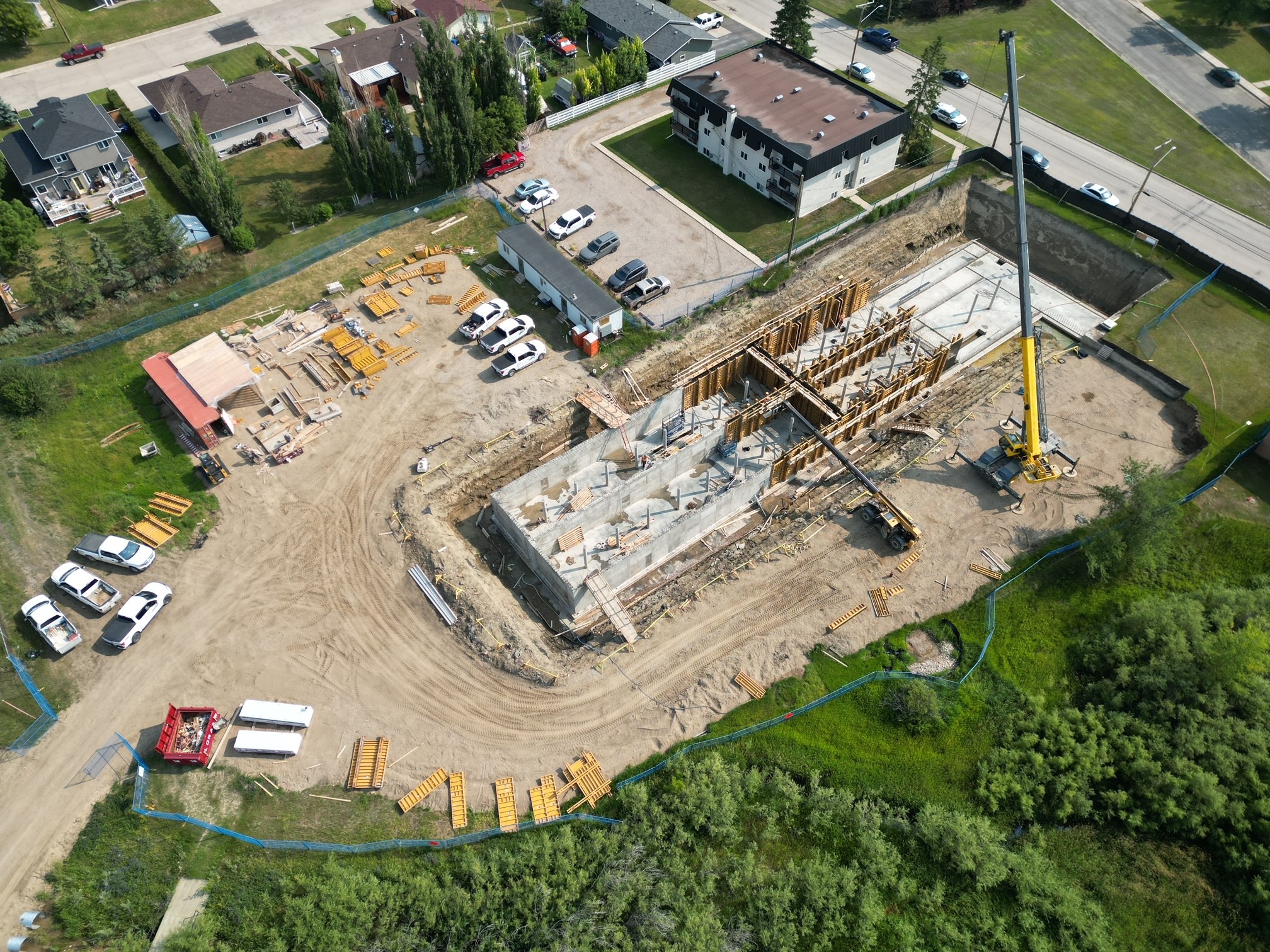

Plant Construction Progress 13
All drone pictures supplied by Carolyn Rempel

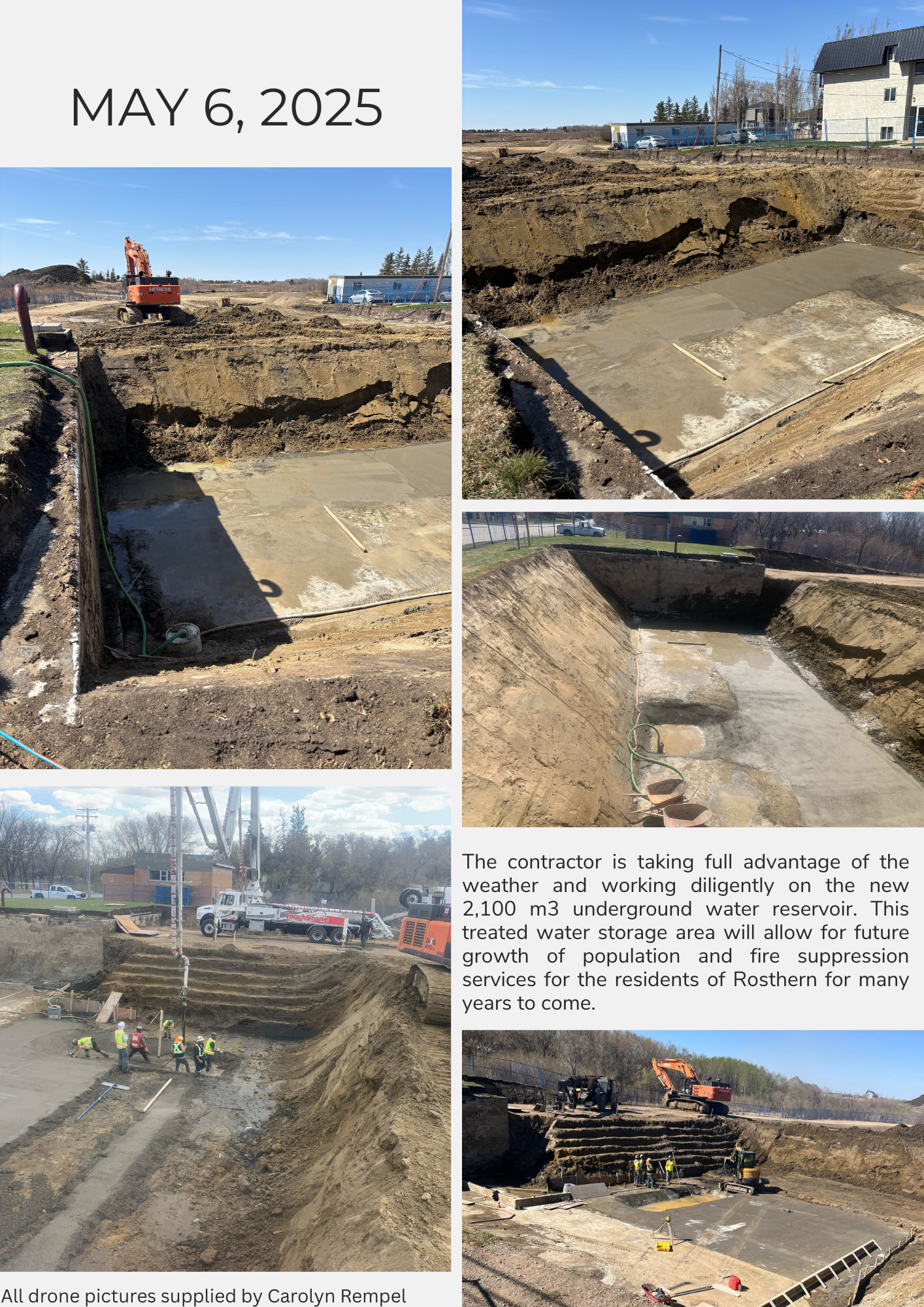

May 6, 2025

CONSTRUCTION CONTINUES

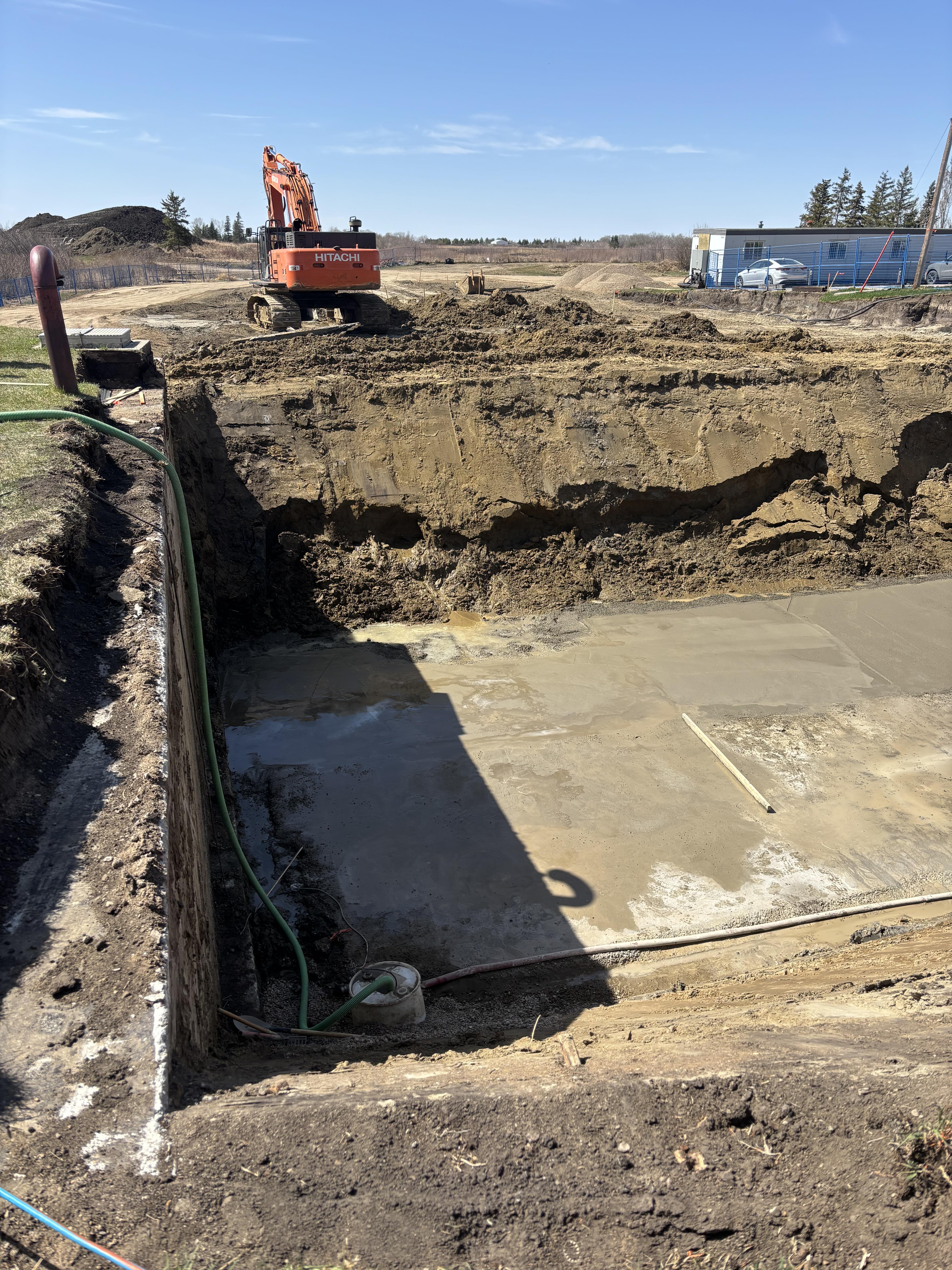

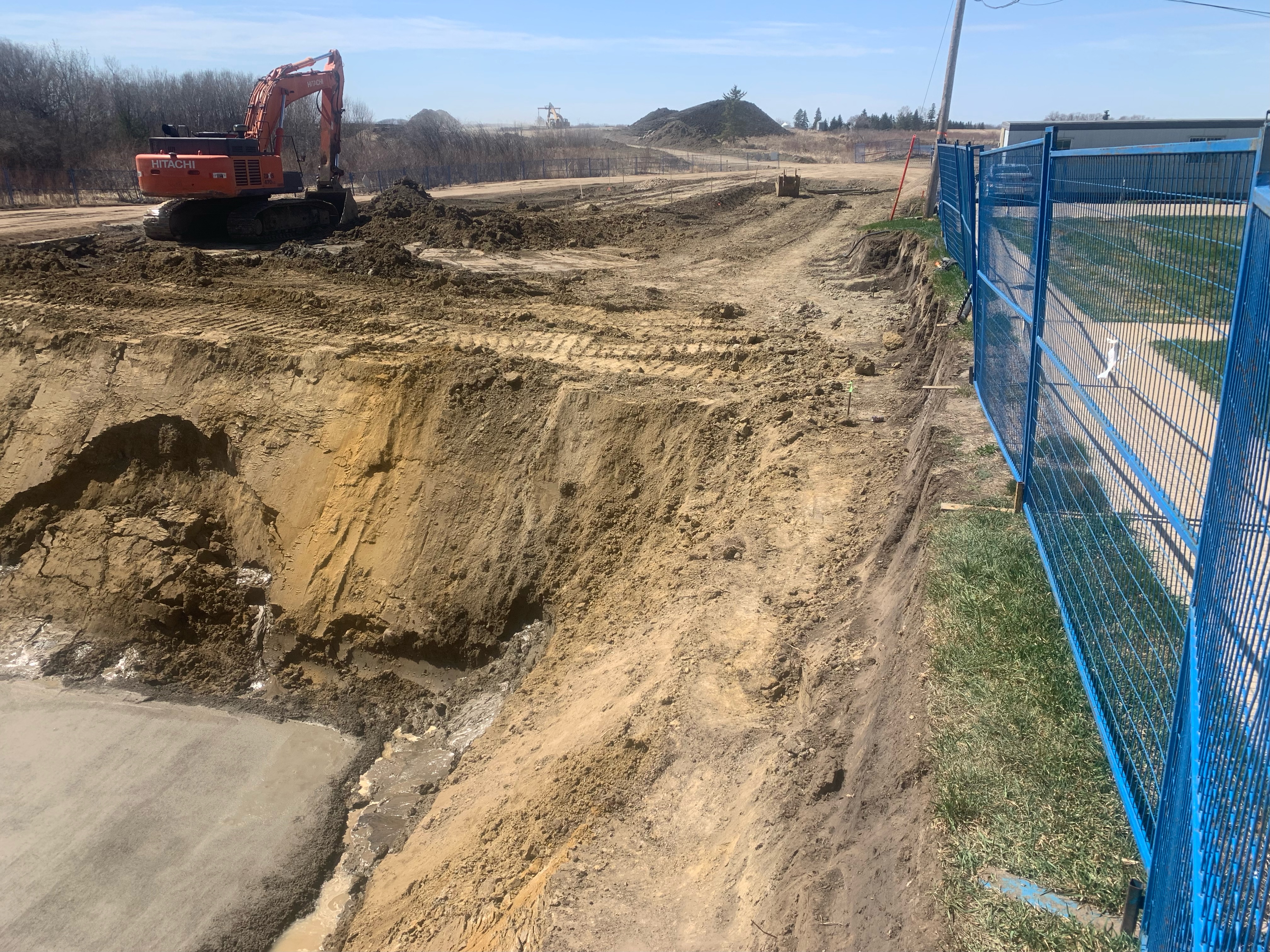

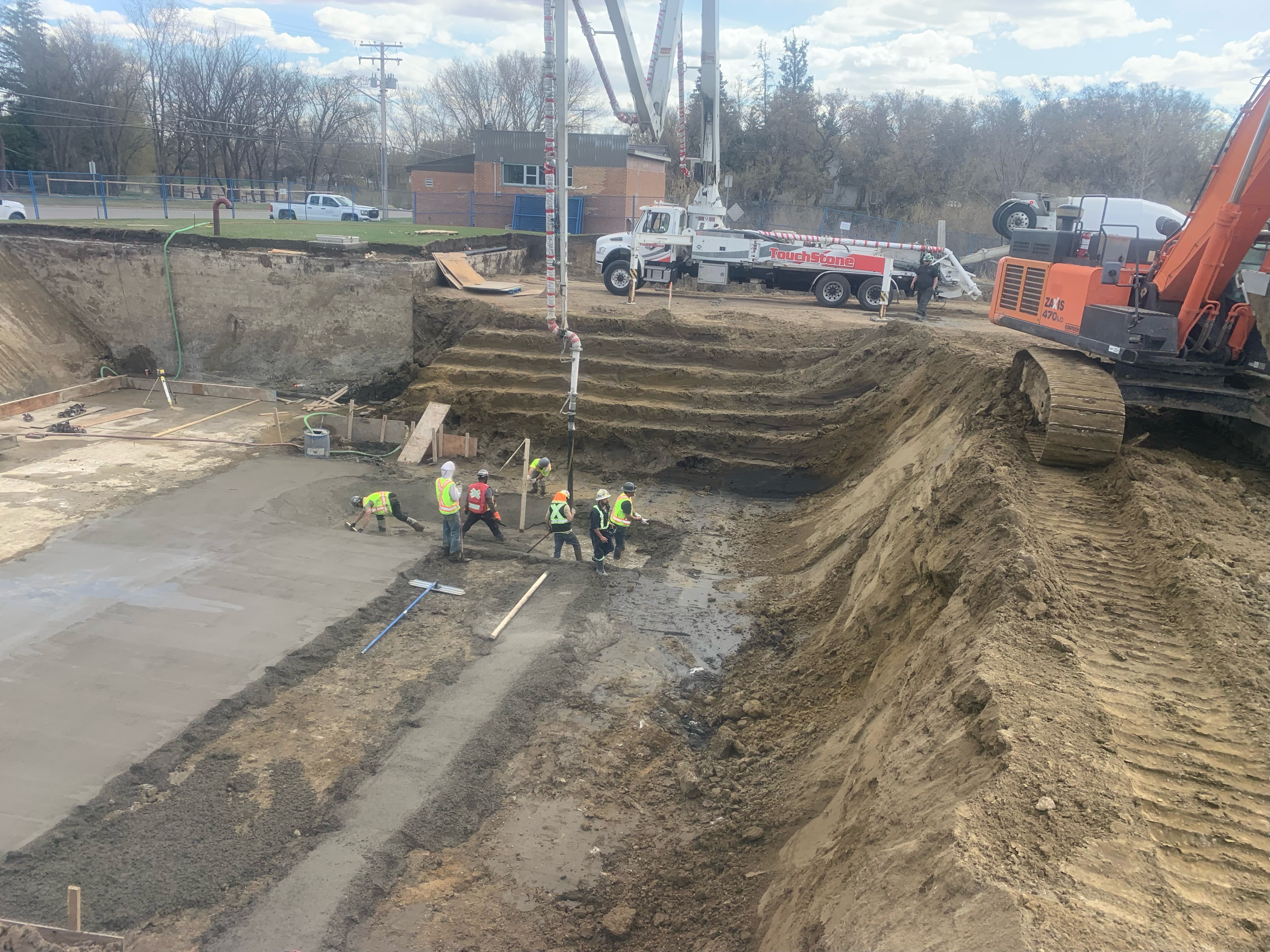

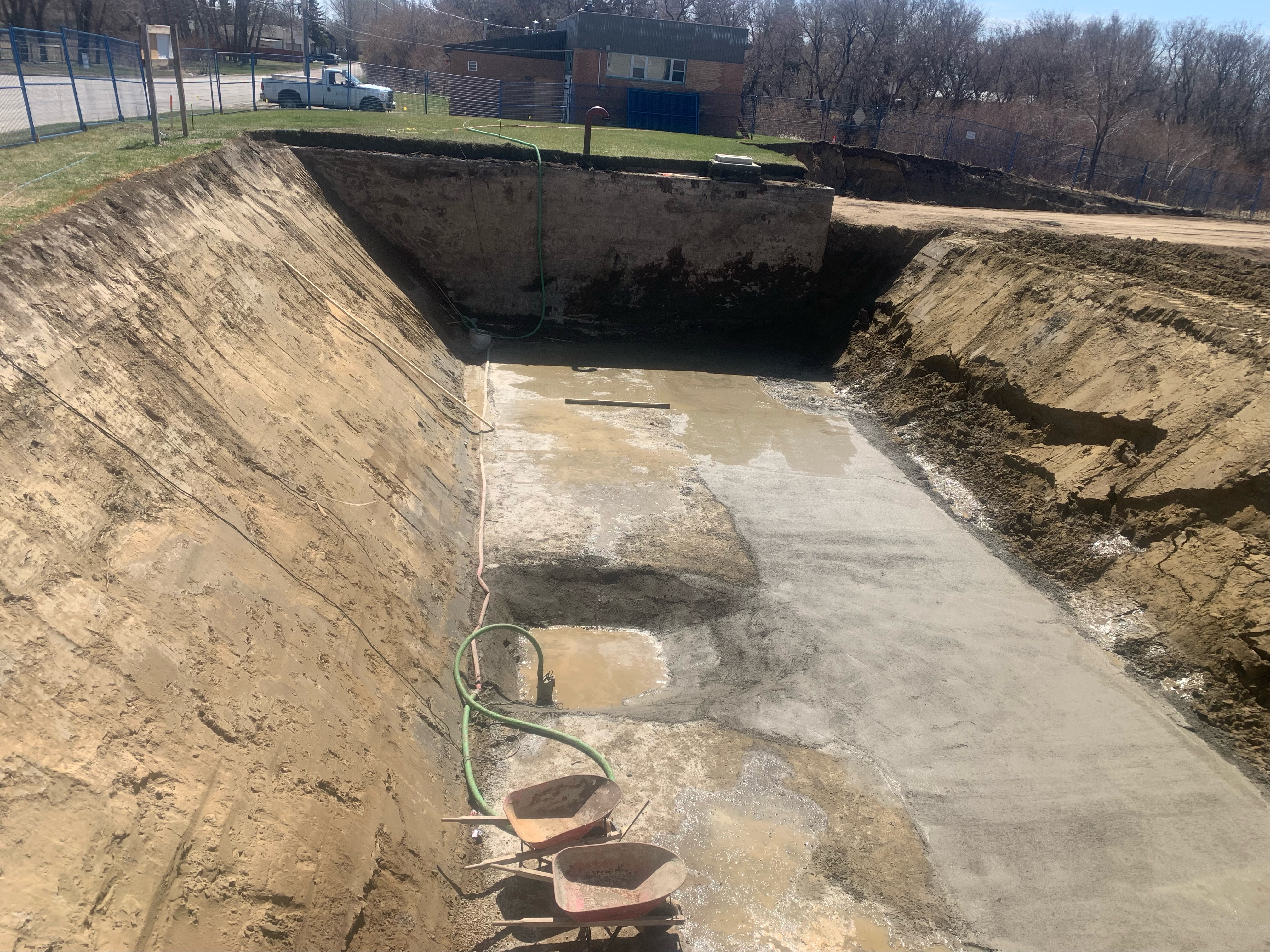

The contractor is taking full advantage of the weather and working diligently on the new 2,100 m3 underground water reservoir. This treated water storage area will allow for future growth of population and fire suppression services for the residents of Rosthern for many years to come.

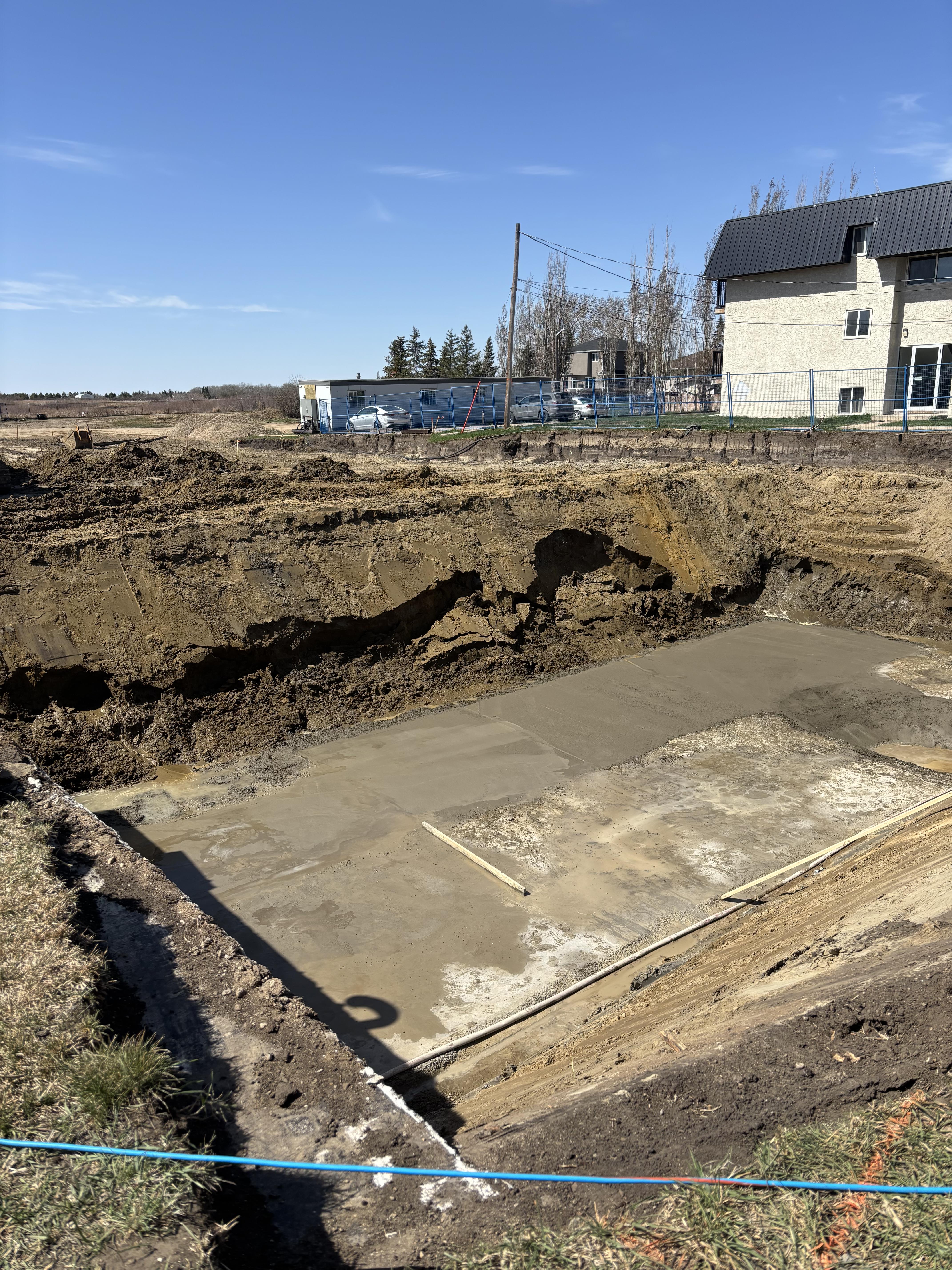

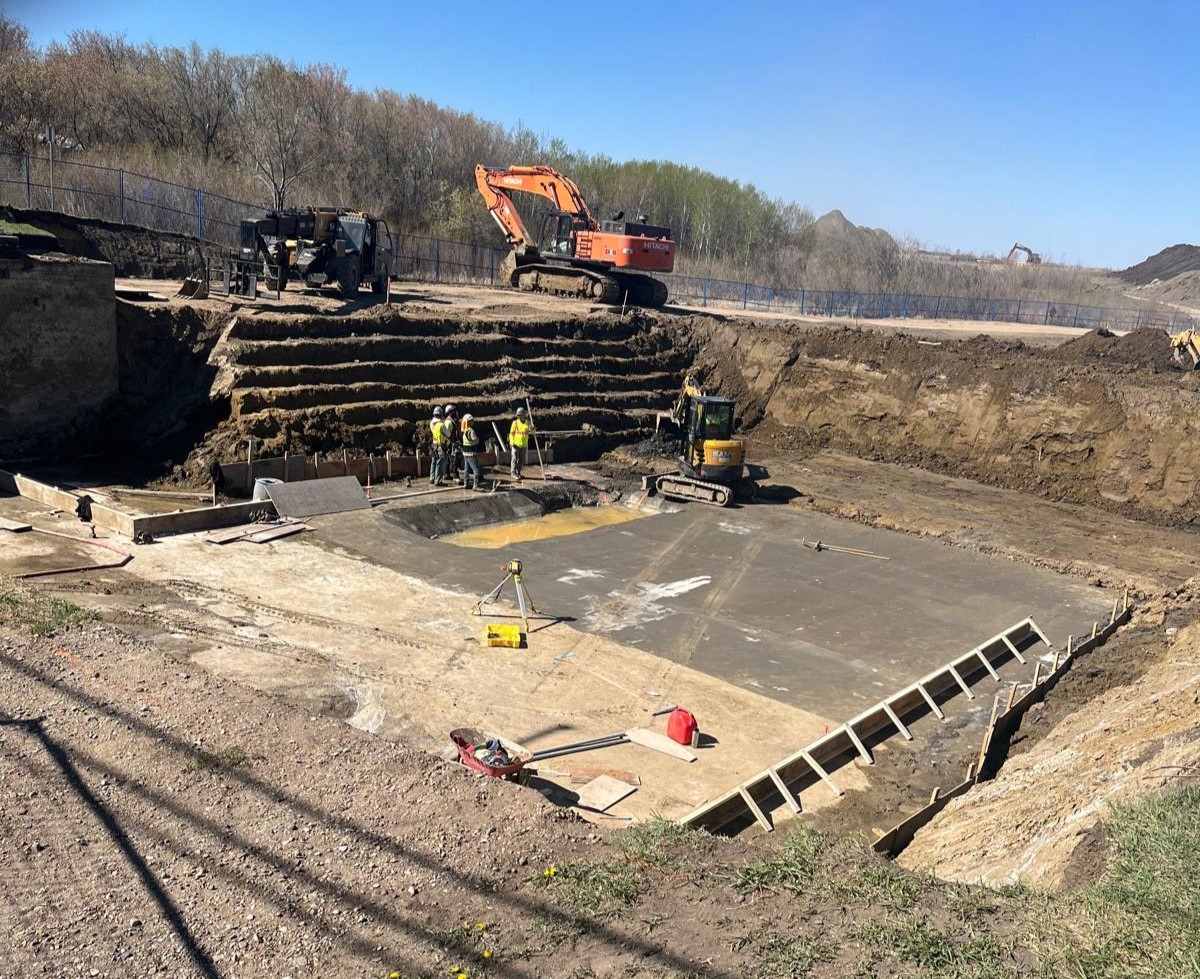

Construction Continues 1 Construction Continues 2 Construction Continues 3
Construction Continues 4 Construction Continues 5 Construction Continues 6

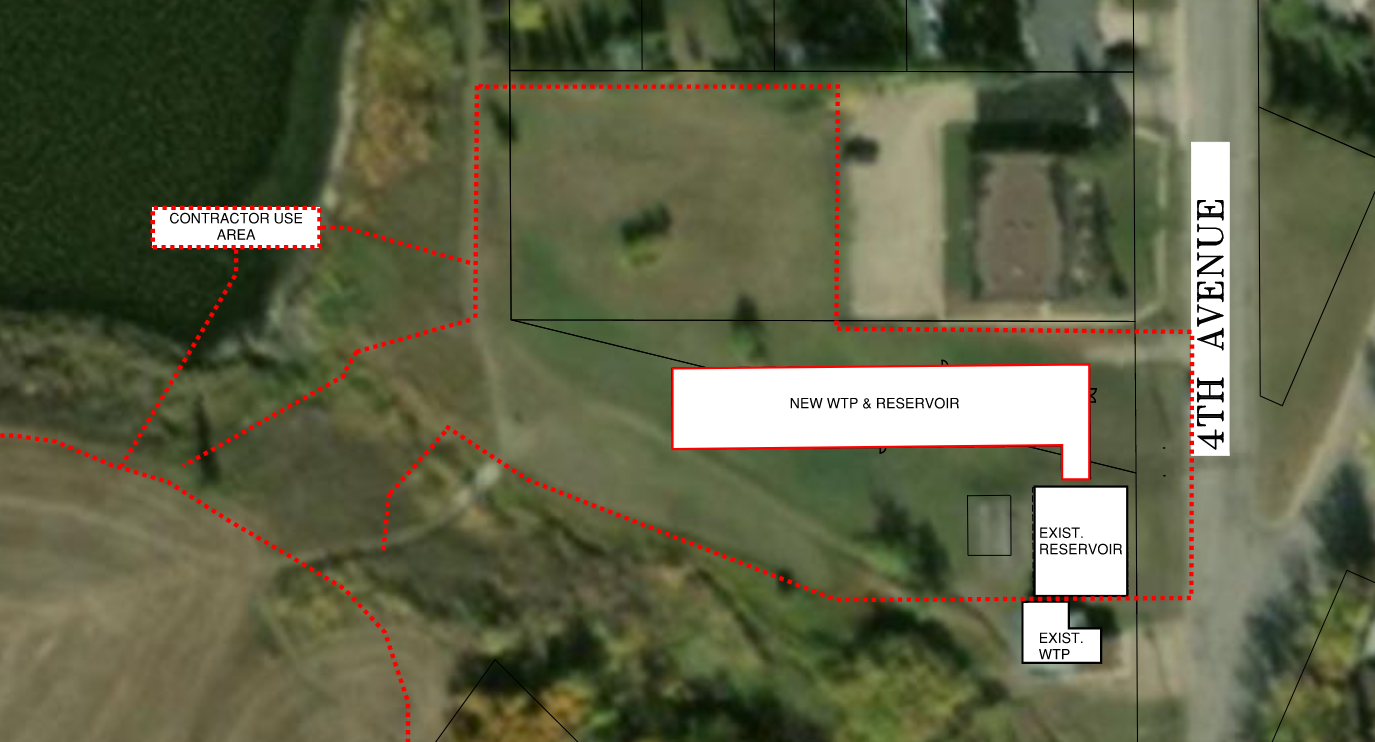

Construction Continues 7



April 25, 2025

CONSTRUCTION HAS BEGUN

This essential project is underway! Barricades and closure signage have been and will remain in place all walking trail access points. In addition, temporary fencing for the construction site has been installed. Please avoid ALL construction areas and obey all signage. The closures are there for the safety of the public and the contractors.




March 14, 2025

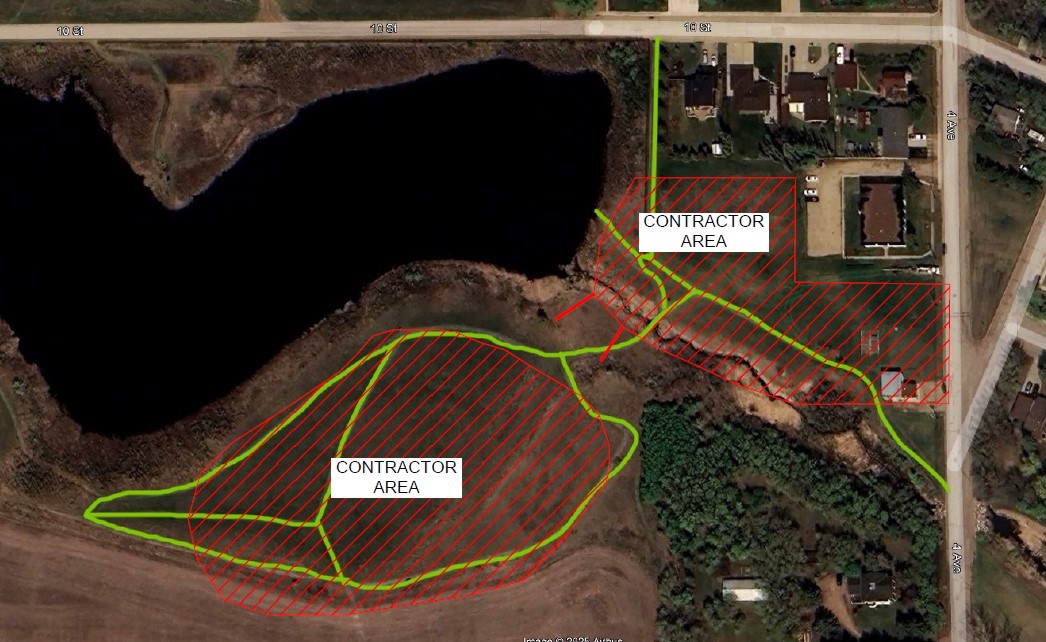

RESERVIOR WALKING TRAIL CLOSURE

Effective Monday, March 17, 2025 until further notice (Projected Timeline: Approximately 14 months)

Staging of heavy equipment and materials for the upcoming Water Supply and Treatment Plant Upgrade Project, will begin on Monday, March 17. Portions of the Walking Trail to the East/Southeast corner of the Reservoir will be closed to allow for construction access and storage. Barricades and trail closure signage will be placed at trail access points, and temporary fencing for the construction site will be installed. Please avoid the closed sections of the trail and obey all signage. The closures are there for the safety of the public and the contractors. Thank you for your patience and cooperation as this essential project gets underway!
